Asphalt Paving Cost FAQ

The following questions are among the most commonly asked by property owners evaluating asphalt paving projects. The answers draw on current market data, industry standards, and practical experience.

If you have any questions you'd like ot be added to our Q&A, please contact us.

Asphalt Paving Fraud FAQ - Purpose Contracting Asphalt

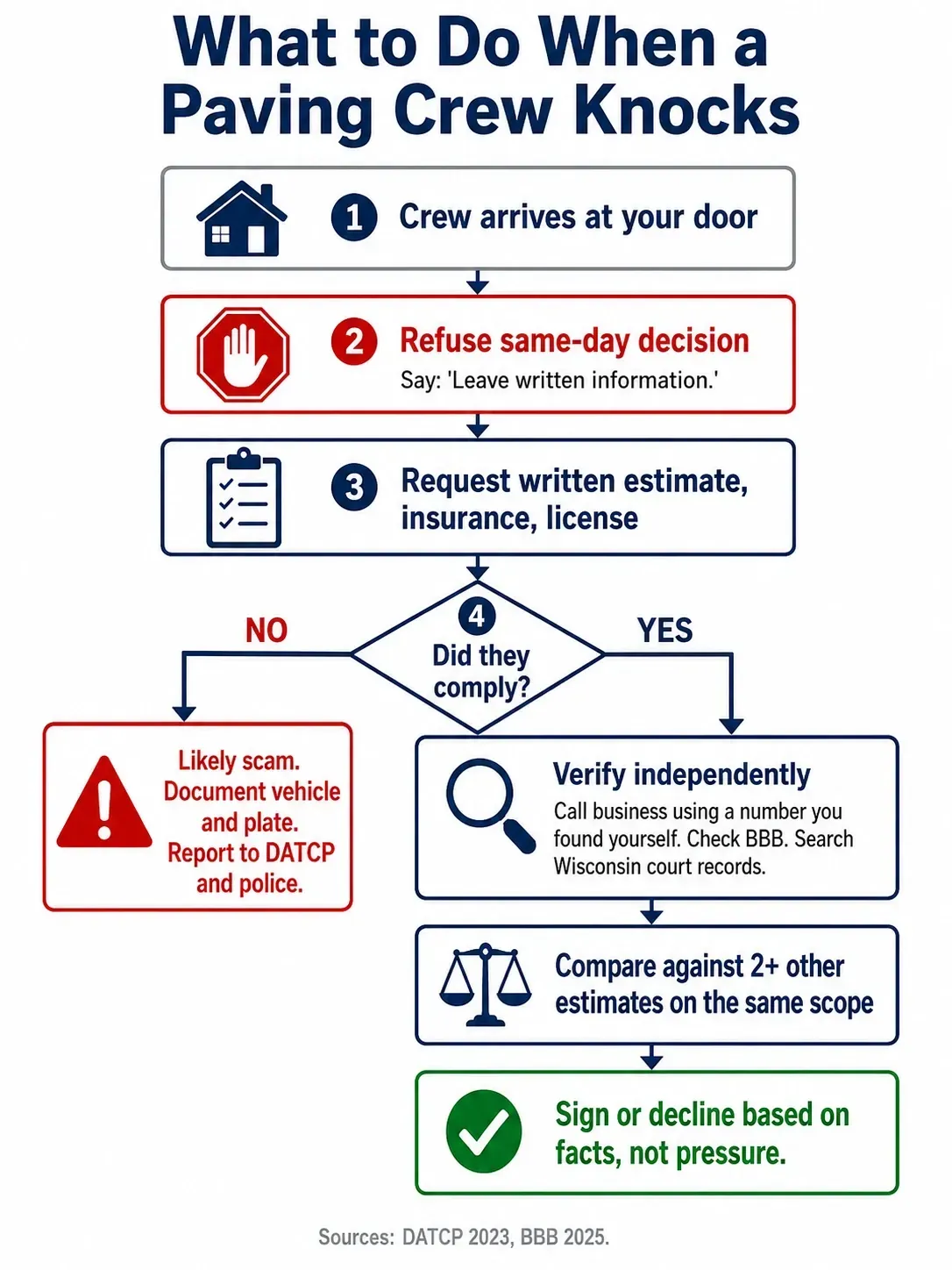

A crew knocks on your door and claims they have leftover hot asphalt from a nearby job. They say it has to be used before it cools. They quote a discounted, cash-only price and pressure the homeowner to decide on the spot. DATCP's September 2023 alert described exactly this pitch in southeastern Wisconsin, including Waukesha County. The story sounds efficient, discourages questions, and is the most common opener used in Wisconsin asphalt fraud.

Sources: [DATCP-2023] [BBB-2025]

→ See Section 1: The leftover-asphalt pitch: why this story keeps working

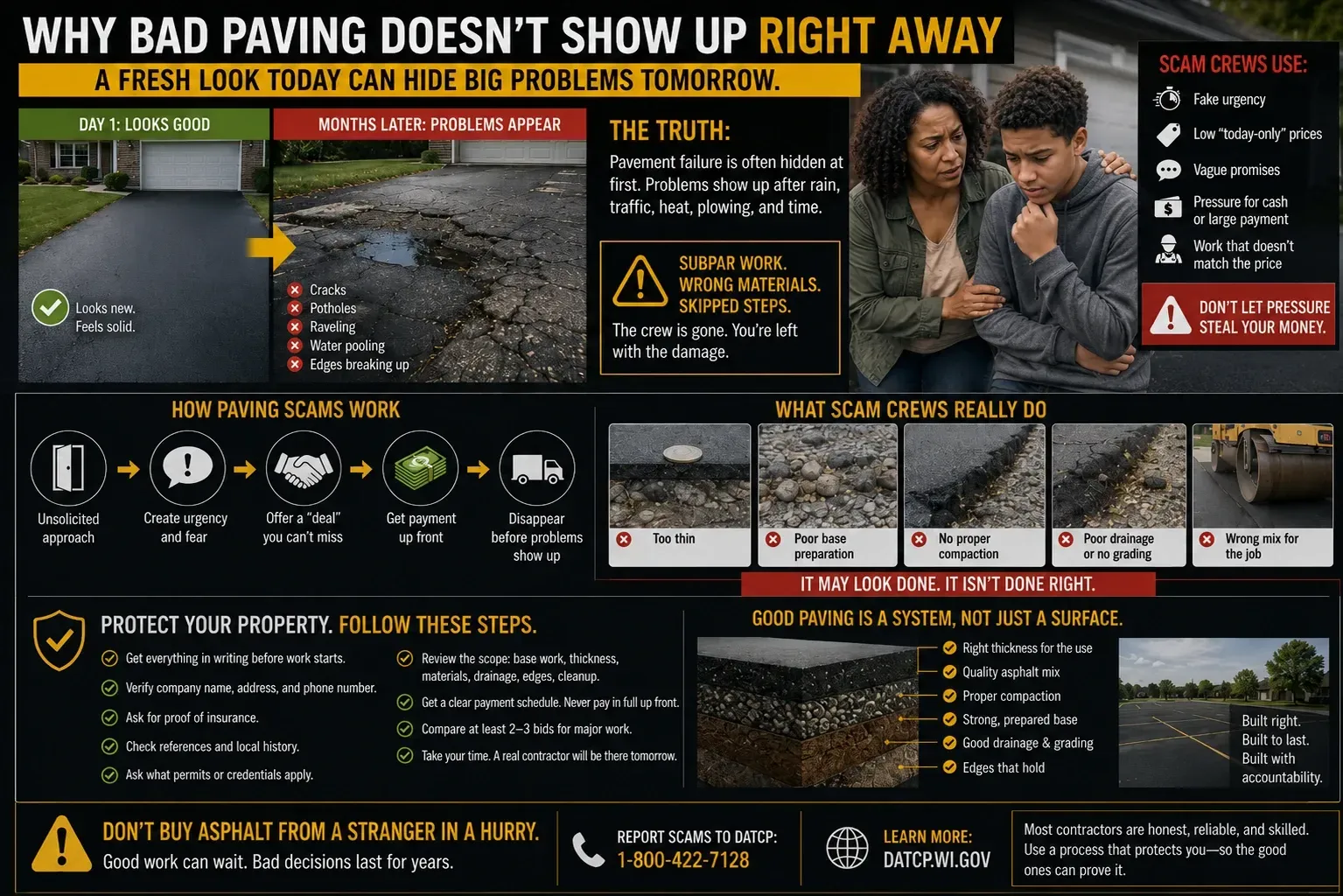

A surface can look dark and fresh on day one, even if the base is weak, the layer too thin, the compaction poor, or the material wrong. CBS 58's 2023 report noted that homeowners often don't realize subpar materials were used until weather, traffic, plowing, or ordinary use exposes the defects. By then the crew is unreachable. Verification has to happen before the work, not after the surface looks new.

Sources: [CBS58-2023] [DATCP-2023]

→ See Section 1: Why bad asphalt paving doesn't show up right away

Once cash changes hands, a homeowner has almost no leverage. DATCP warns never to pay the full price up front. BBB and TMJ4 report that scam crews routinely demand a large percentage before any meaningful work is done. CBS 58 and TMJ4 both recommend paying by credit card when possible, because card payments create documentation and a dispute path that cash never does.

Sources: [BBB-2025] [DATCP-2023] [TMJ4-2026] [CBS58-2026]

→ See Section 1: Cash up front, then disappear

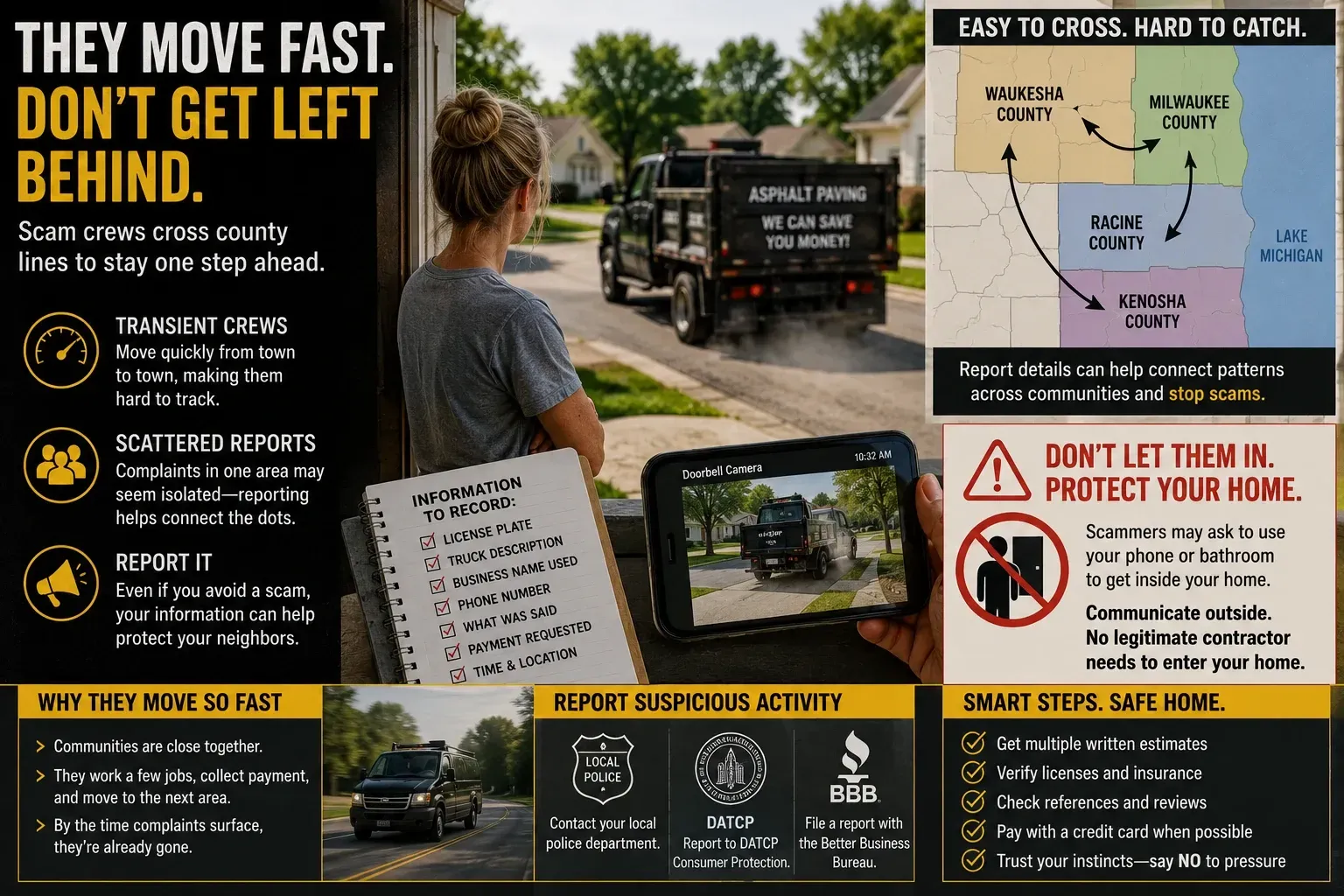

Southeastern Wisconsin counties sit close together. A crew can move through Waukesha, Milwaukee, Racine, and Kenosha faster than scattered reports can be connected. DATCP specifically warned in 2023 that transient workers can move quickly from town to town, making them difficult to track. Mobility is why reporting matters even when no money was lost — license plates and descriptions help link patterns across communities.

Sources: [DATCP-2023]

→ See Section 1: Why these crews move so fast across county lines

The reliable warning isn't one behavior — it's the combination. Unsolicited approach. Urgent deadline. Leftover-materials story. Big discount. No written scope. Vague business identity. Out-of-state info. Big upfront payment demand. Pressure against comparing bids. Unclear warranty. One fact alone may not prove fraud. Together they form a pattern documented by DATCP, BBB, and local police.

Sources: [BBB-2025] [DATCP-2023]

→ See Section 1: The pattern: warning signs that show up together

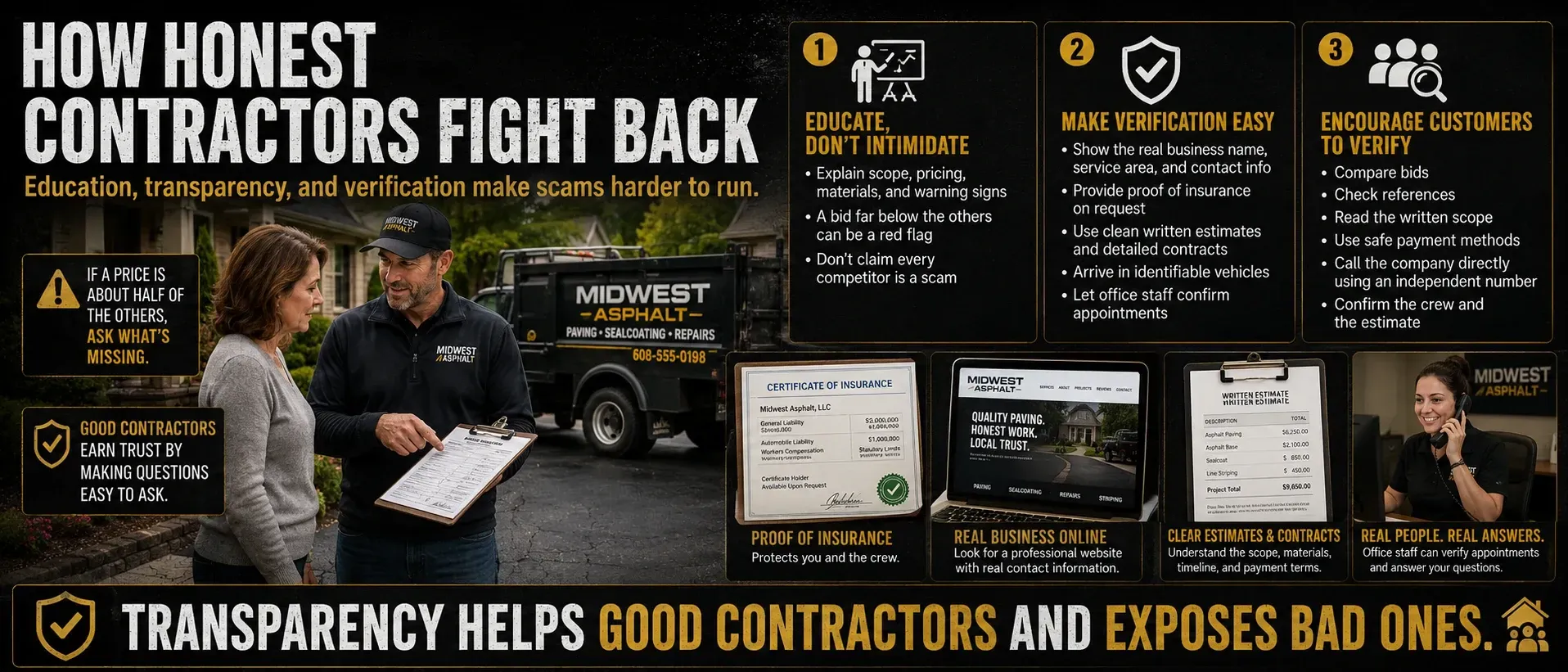

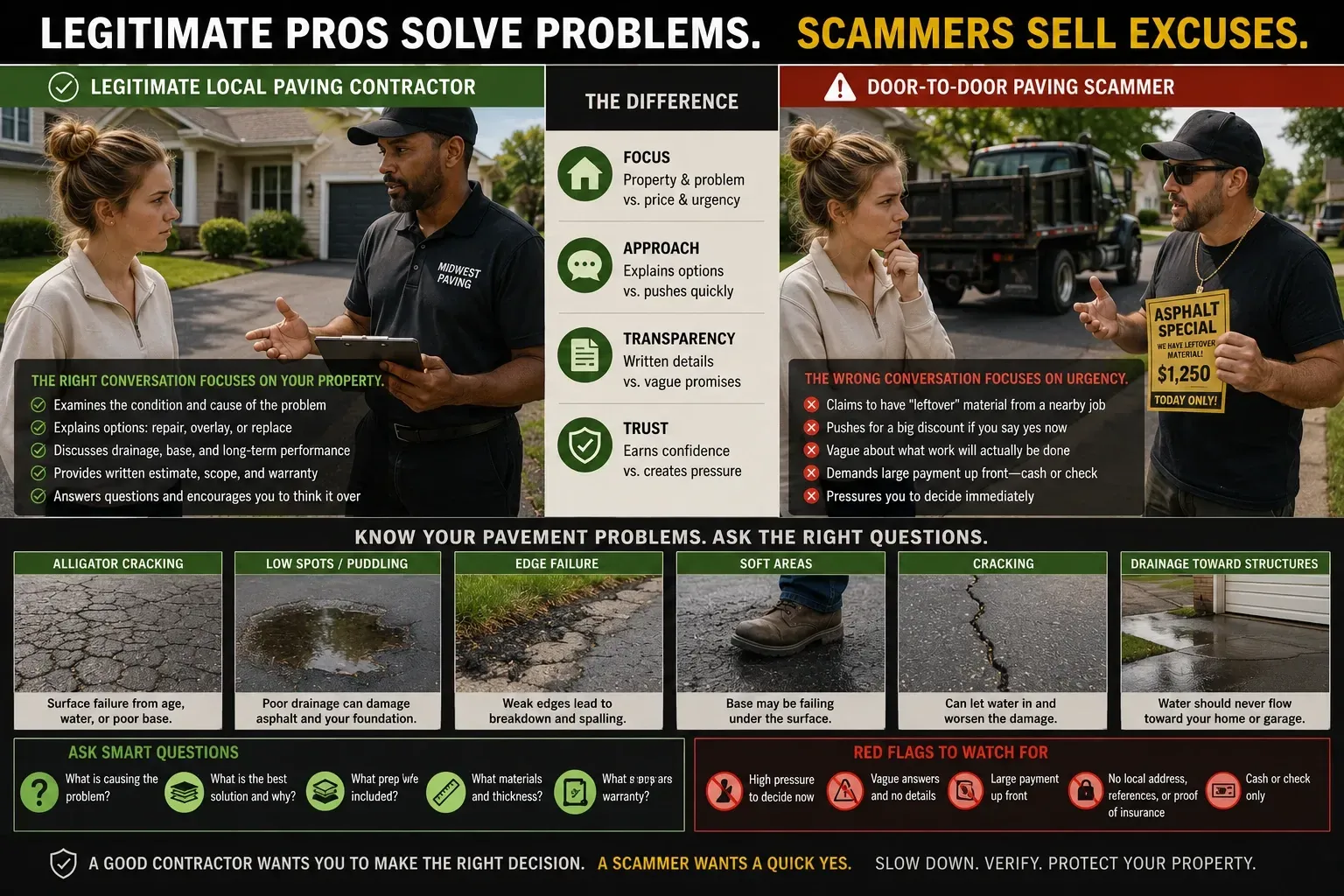

A legitimate contractor talks about the property, not just the price. They ask about the existing base, drainage, traffic load, freeze-thaw damage, low spots, and edge condition. They explain whether the right answer is overlay, patching, sealcoating, or full remove-and-replace. A scammer focuses on price and urgency; a professional focuses on cause and scope.

Sources: [DATCP-HI]

→ See Section 1: What a real local contractor sounds like

Scammers target older homeowners, people who seem isolated, busy property managers, and customers trying to dodge a bigger repair bill. The Minnesota Attorney General's 2025 Community Blacktop case and the North Carolina conviction of Lige "Larry" Boswell both named elder targeting explicitly. Pressure may look like friendliness, sympathy, or a same-day favor, not bullying.

Sources: [TMJ4-2026] [BBB-2025]

→ See Section 1: Who scammers target — and how to protect them

Families should agree in advance: no paving, roofing, tree, or repair contract gets approved at the door without a phone call to a trusted person first. That's about creating backup, not removing independence. Franklin Police, via TMJ4, made the same point in 2026: victims aren't alone and shouldn't decide alone. Talking before asphalt paving season is far cheaper than recovering money afterward.

Sources: [TMJ4-2026] [BBB-2025]

→ See Section 1 and Section 2, Step 22

A bad parking-lot job creates trip hazards, ponding water, ADA-route problems, plow damage, and early failure. Apartment complexes, senior living, churches, retail, and warehouses pay the highest price — losses scale with lot size. DATCP warns that commercial asphalt paving requires planning, staging, traffic control, and documentation, none of which a same-day pitch provides. Property managers should refuse any walk-up offer.

Sources: [DATCP-2023] [DATCP-HI]

→ See Section 1: Commercial properties: bigger lots, bigger losses

Sealcoating is a surface maintenance service that protects and refreshes asphalt under the right conditions. It does not rebuild a failed base, restore structural thickness, or make alligator cracking disappear. Asphalt paving involves asphalt placement, compaction, and often base preparation or removal. When a door-to-door crew uses vague phrases like "blacktop it" or "lay some material over it," slow the conversation down.

Sources: [DATCP-HI] [BBB-2025]

→ See Section 1: What a real local contractor sounds like

No. DATCP provides consumer-protection guidance, takes complaints, and enforces certain rules, but it does not issue blanket approvals of individual contractors. A contractor claiming to be "DATCP approved" is using language DATCP itself does not use. Look instead for registered business information, applicable DSPS credentials, insurance, written contract, references, BBB history, and local presence.

Sources: [DATCP-HI] [DSPS-DC]

→ See Section 1: Who scammers target — and how to protect them

Don't buy asphalt from a stranger in a hurry. That doesn't mean every surprise offer is criminal — it means slow the transaction down until it becomes verifiable: legal company name, physical address, written estimate, proof of insurance, references, applicable credentials, payment schedule, and warranty. A real contractor will still exist tomorrow. A scammer often won't.

Sources: [BBB-2025] [DATCP-2023]

→ See Section 1: The simple rule

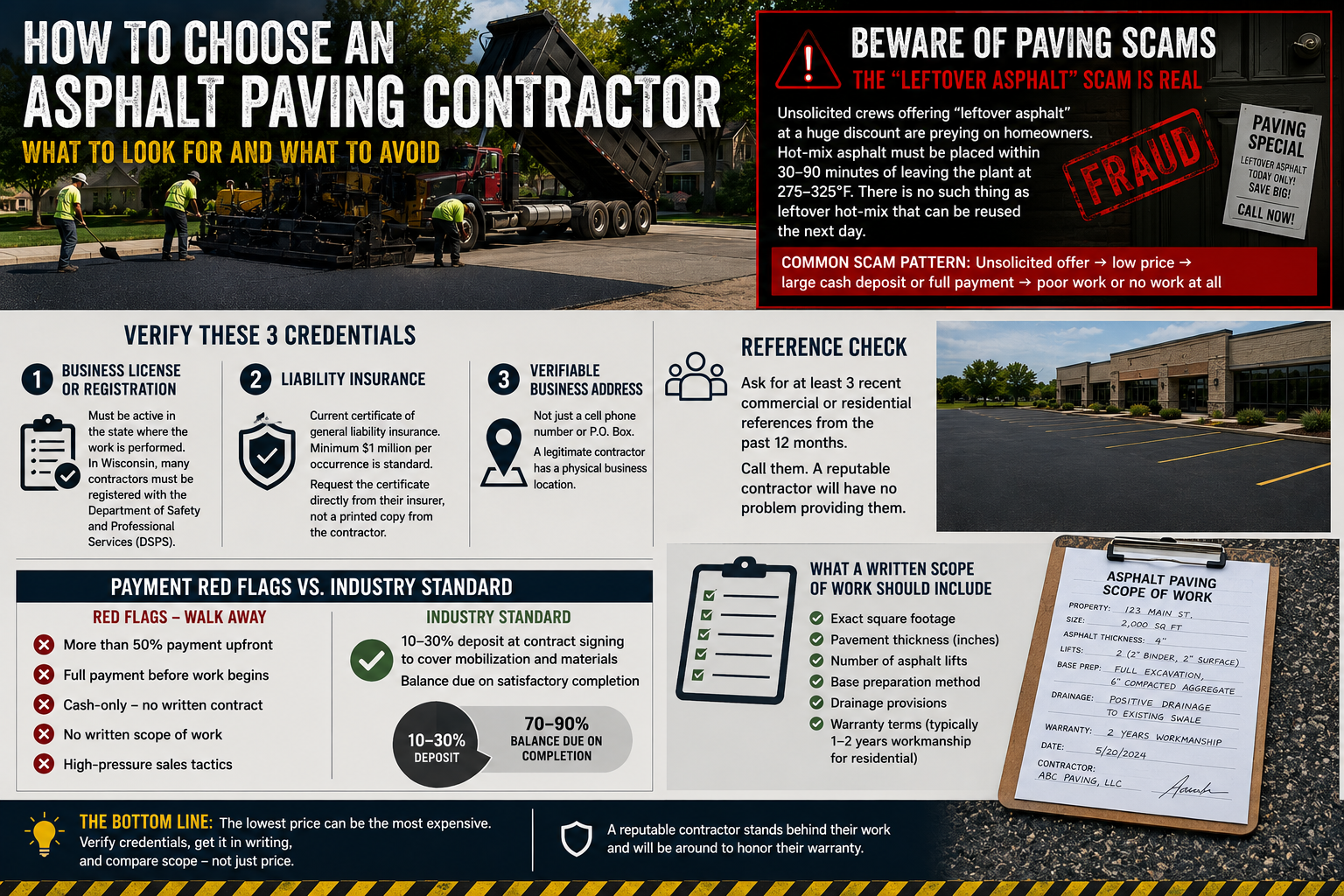

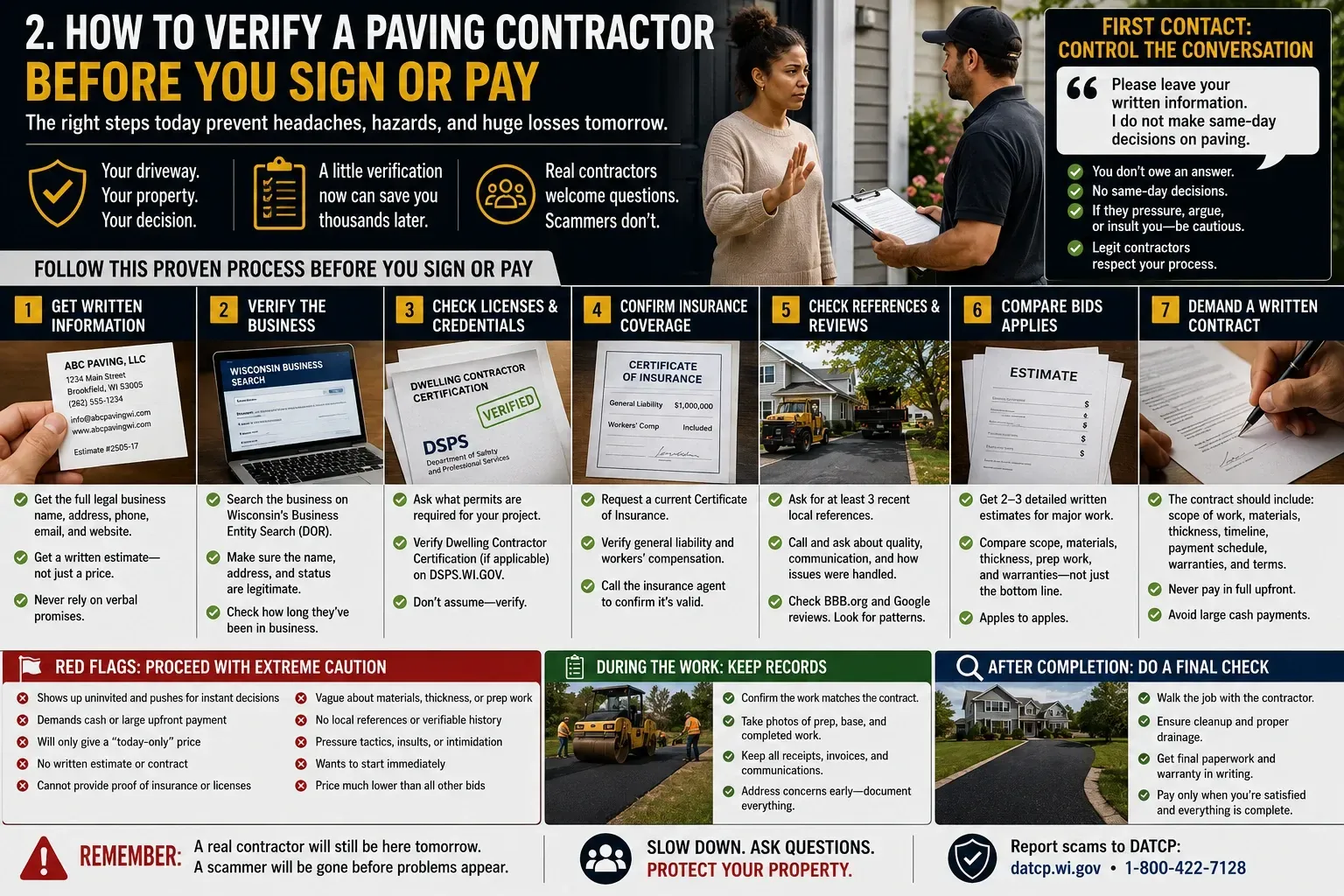

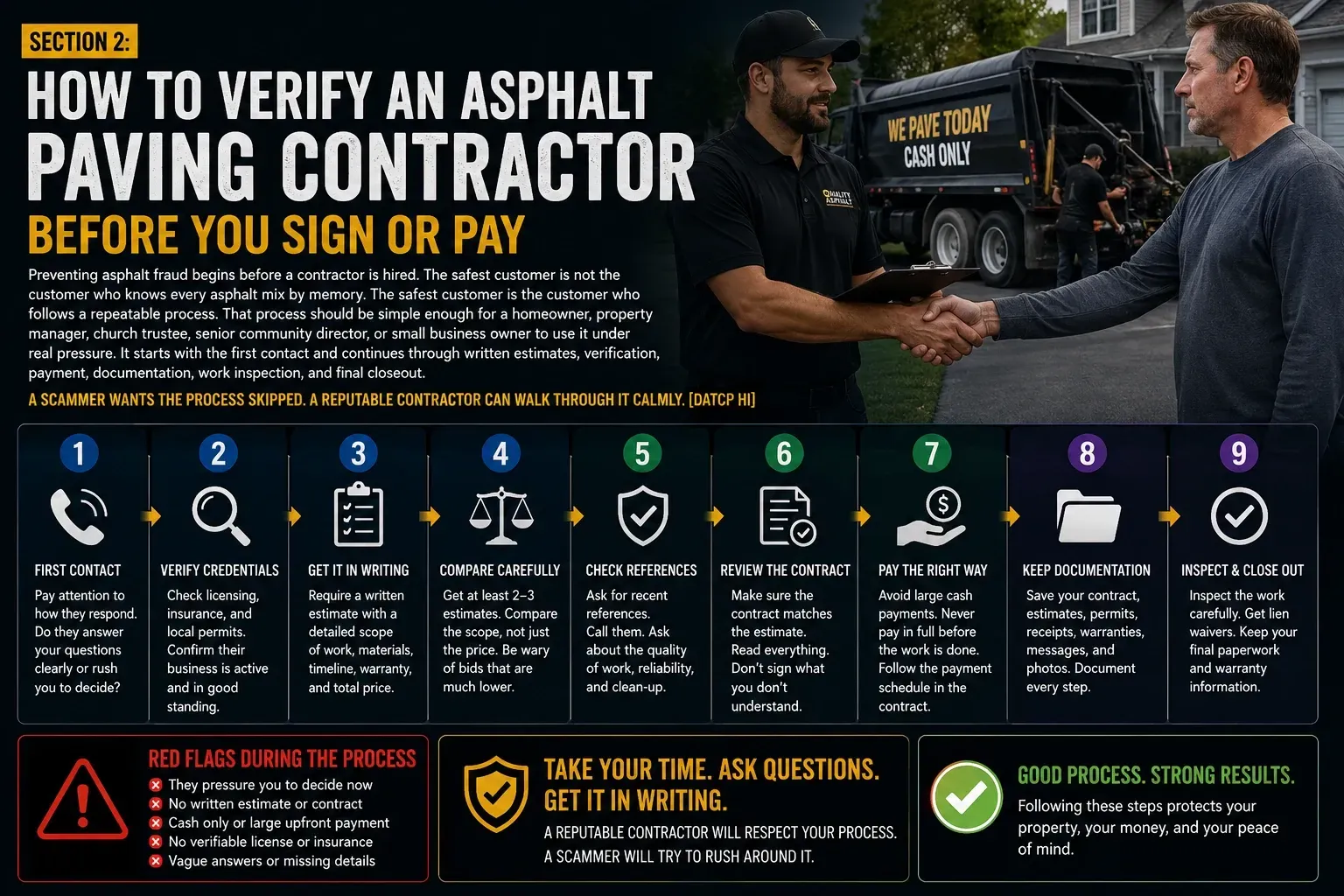

Section 2 — How to Verify an Asphalt Paving Contractor

Use one repeatable line: "Please leave your written information. I do not make same-day decisions on asphalt paving." That single sentence removes the urgency the scam depends on. DATCP advises consumers to refuse high-pressure tactics from transient workers and never feel obligated to decide on the spot. If the crew becomes argumentative after a calm refusal, the risk isn't only the driveway — it's the seller.

Sources: [DATCP-HI]

→ See Section 2, Step 1

Get the legal company name, trade name, address, phone, email, website, salesperson's name, and crew names. DATCP says contracts must include a physical business and salesperson address — not just a P.O. box. Then verify independently: search the business, check BBB complaint history, contact DATCP's Bureau of Consumer Protection at 1-800-422-7128, and confirm phone numbers and websites match across sources.

Sources: [DATCP-HI] [CBS58-2026]

→ See Section 2, Steps 2–3

Ask for a certificate of insurance listing your name and address as the certificate holder. DATCP says any consumer can request this. The certificate shows an active policy and notifies the homeowner if coverage expires. "We're insured" is not the same as proof. A professional operation is used to this request. A suspicious crew often stalls or becomes defensive.

Sources: [DATCP-HI]

→ See Section 2, Step 4

Wisconsin rules are not identical for every situation. DATCP explains that if a contractor performs certain general construction work on one- or two-family homes and pulls building permits, the contractor must have Dwelling Contractor Certification and Dwelling Contractor Qualifier Certification from DSPS. Ask the contractor which permits or credentials apply to your specific job and verify any claim with the issuing agency.

Sources: [DATCP-HI] [DSPS-DC] [DSPS-DCQ]

→ See Section 2, Step 5

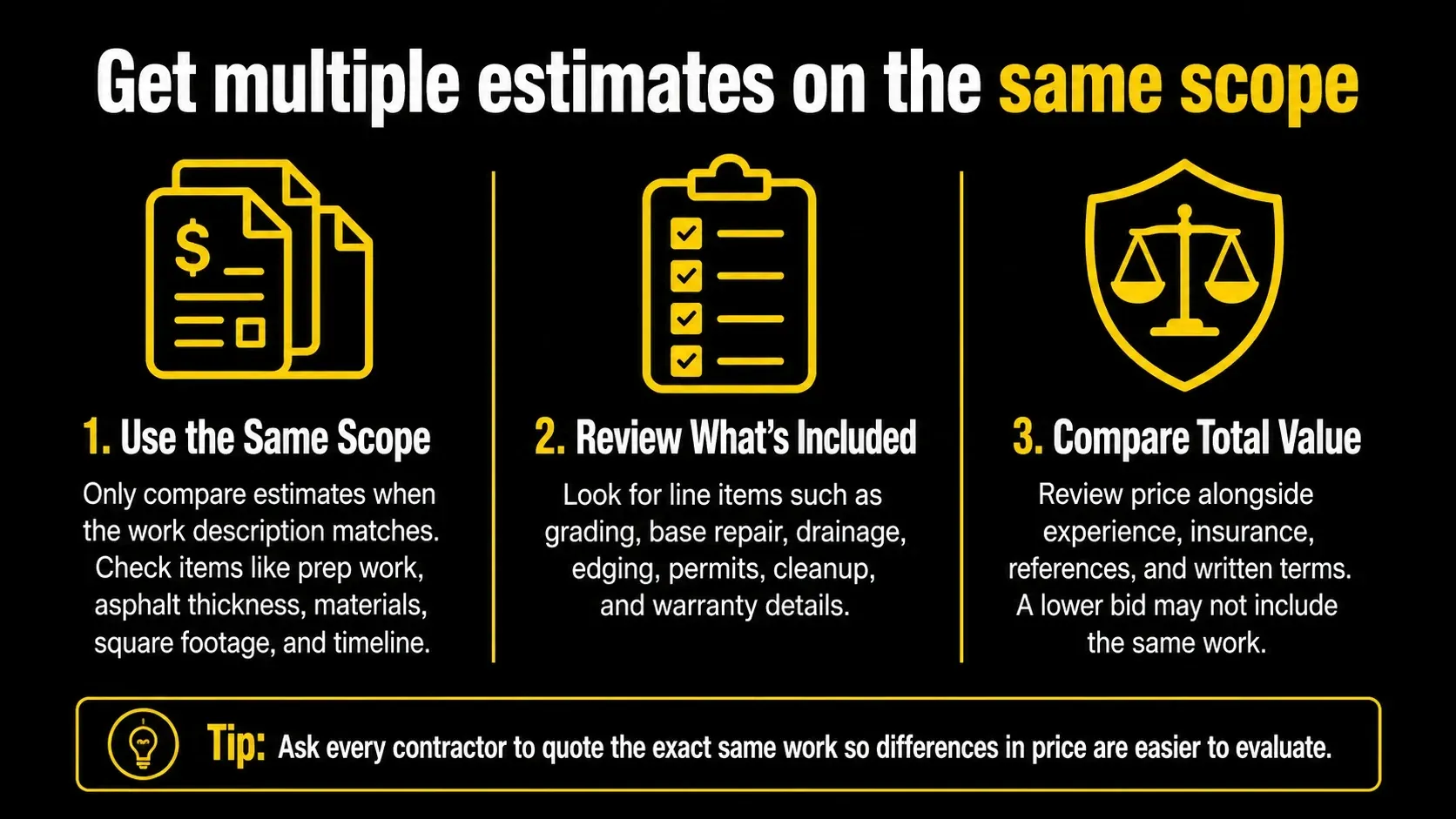

At least two, ideally three, on the same scope. DATCP recommends multiple bids and making sure every contractor is bidding on the same work. One bid may be sealcoating, another a two-inch overlay, another full removal and replacement — those numbers aren't comparable. Ask each bidder to identify square footage, preparation, thickness, material, compaction, edges, drainage, transitions, cleanup, schedule, warranty, and exclusions.

Sources: [DATCP-HI] [CBS58-2023]

→ See Section 2, Step 6

DATCP says a contract should include the job description, materials, total price, start and completion dates, warranty terms, and both the company and salesperson addresses. If any payment is required before work is done, a written contract is required by Wisconsin law. Avoid vague phrases like "pave the driveway" — specify area, removal depth, base prep, asphalt type, compacted thickness, transitions, drainage, edging, cleanup, and warranty.

Sources: [DATCP-HI] [CBS58-2026]

→ See Section 2, Steps 7–8

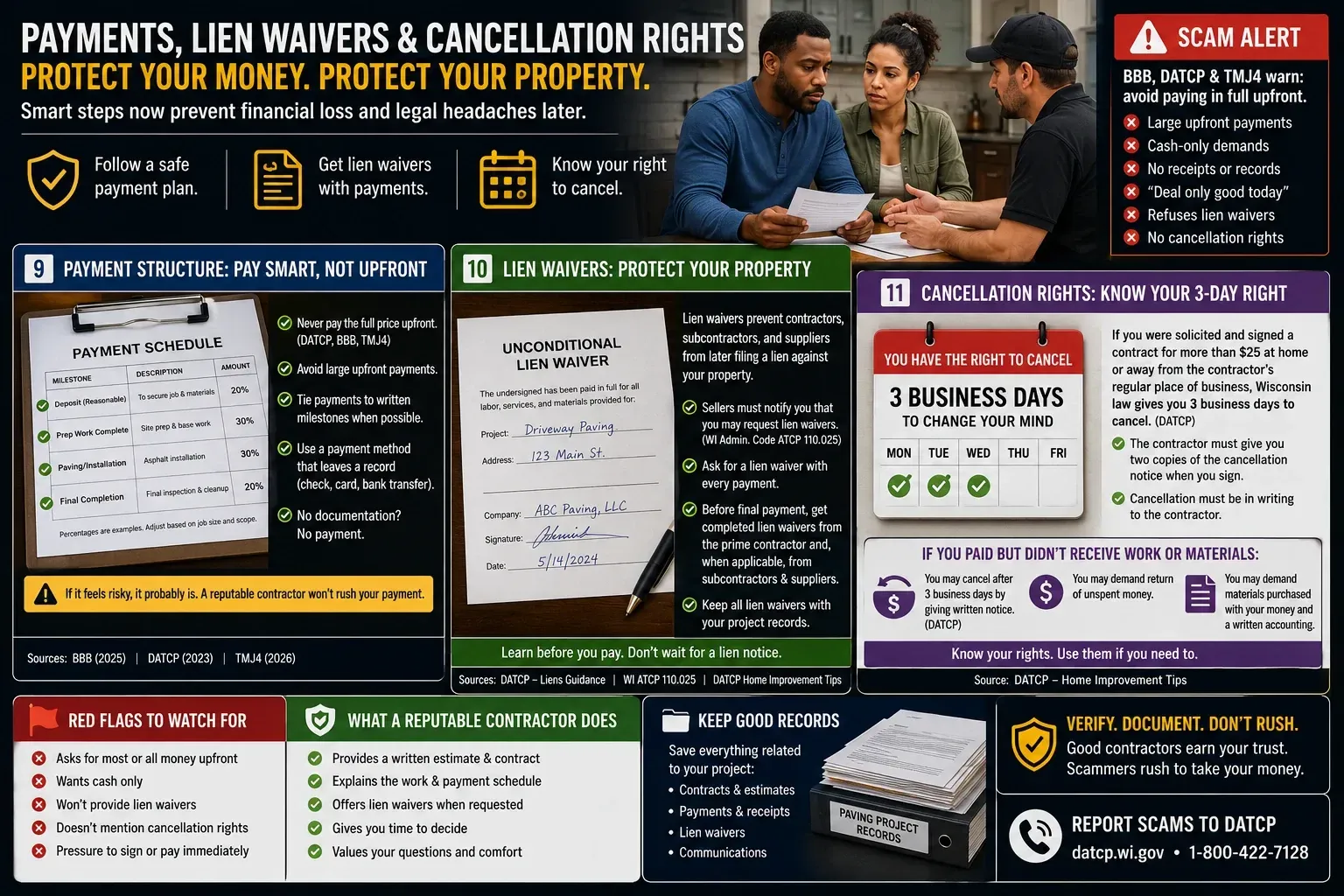

Never pay the full price up front — DATCP, BBB, and TMJ4 all repeat this. Tie payments to written milestones. Use a credit card when possible because cards create a record and may give consumers help from the card company. Cash and checks are especially risky with a stranger at the door, because once they change hands the customer has little practical leverage.

Sources: [BBB-2025] [DATCP-2023] [TMJ4-2026]

→ See Section 2, Step 9

A lien waiver stops a subcontractor or supplier from collecting from a homeowner who already paid the prime contractor. Wisconsin Administrative Code ATCP 110.025 requires sellers to give notice that consumers may request written lien waivers at or before payment. DATCP says always to request them. Ask for completed waivers before final payment — and during installment payments on larger jobs.

Sources: [WI-ATCP-110.025] [DATCP-LIENS] [DATCP-HI]

→ See Section 2, Step 10

Yes, under specific conditions. For door-to-door home solicitation contracts over $25, Wisconsin gives consumers three business days to cancel, and the contractor must provide two cancellation copies at signing. The right is set out in Wisconsin's Direct Marketing rule (ATCP 127). A contractor who refuses to discuss cancellation rights is not making the situation safer.

Sources: [DATCP-HI]

→ See Section 2, Step 11

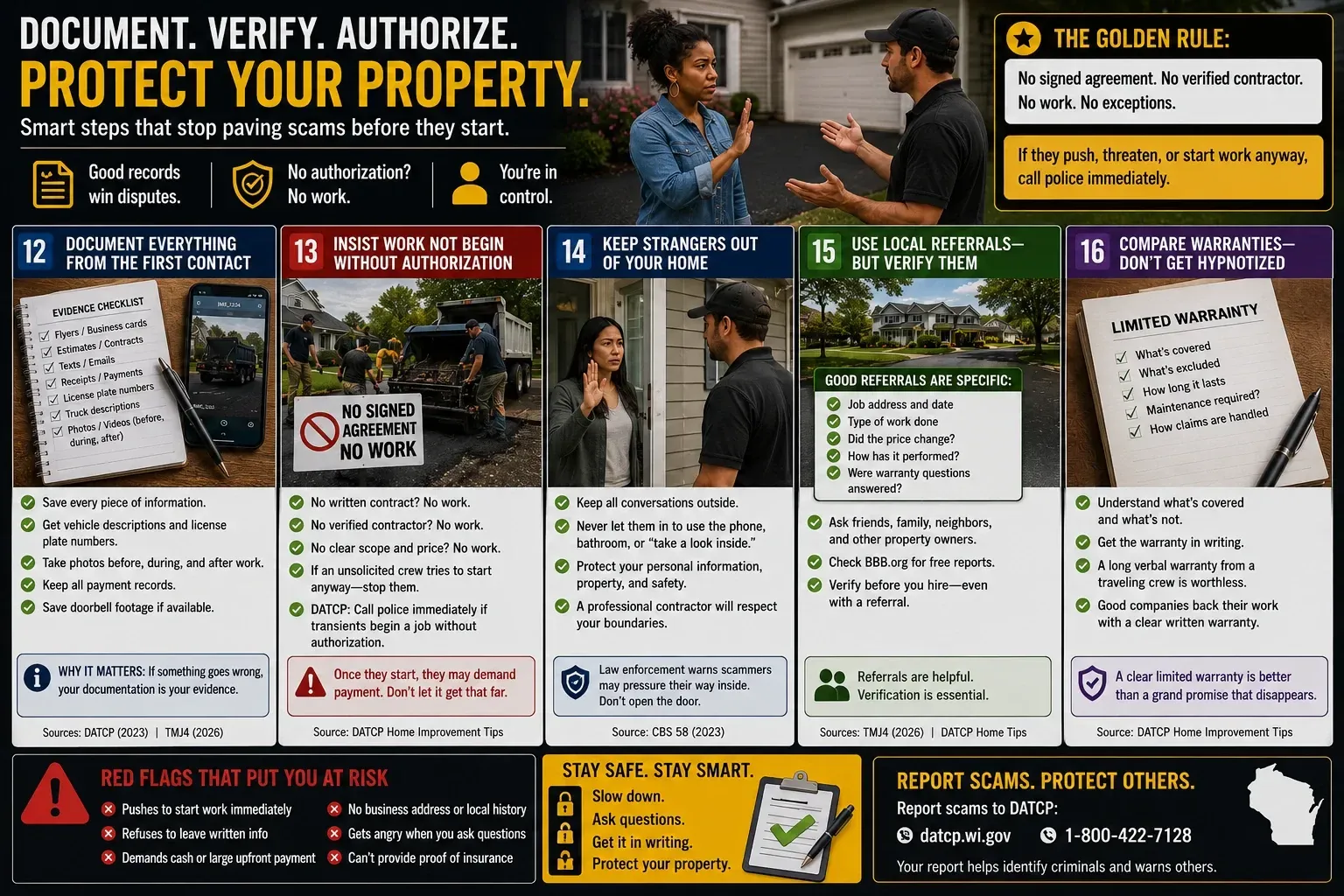

Save everything: flyers, business cards, estimates, texts, contracts, receipts, license plates, truck descriptions, doorbell footage, payment records, and photos of the driveway before, during, and after work. DATCP and Franklin Police both stress that this evidence helps identify scammers and warn others. Documentation turns an upsetting story into useful evidence.

Sources: [DATCP-2023] [TMJ4-2026]

→ See Section 2, Step 12

Call local law enforcement immediately. DATCP's home improvement guidance is explicit on this point. You are not obligated to pay for unsolicited work, and "they already started" is not a valid reason to hand over money under pressure. Keep the conversation outside, do not let strangers into the home, and document everything you can safely capture.

Sources: [DATCP-HI] [CBS58-2023]

→ See Section 2, Steps 13–14

A clear written warranty states what's covered, what's excluded, how long it lasts, what maintenance is required, and how to file a claim. DATCP advises that contracts include a warranty statement for materials, labor, or services. A long verbal warranty from a traveling crew has no enforceable value once the crew leaves Wisconsin. A clear limited written warranty from a verifiable local company is real protection.

Sources: [DATCP-HI]

→ See Section 2, Step 16

Different property types have different needs. A residential driveway, condo drive lane, church lot, school lot, warehouse dock, and senior living facility each face their own traffic, plowing, ADA, and drainage challenges. Heavy vehicles, fire access, and turning movements can change what the pavement actually needs. A contractor giving the same quick answer for every property may not be evaluating the job.

Sources: [DATCP-HI]

→ See Section 2, Step 17

Honest contractors may disagree with one another, but they should be able to explain their reasoning. Ask why they recommend overlay instead of removal. Ask what happens to cracks. Ask whether drainage needs correction. Ask what thickness they propose. A trustworthy contractor understands that questions are part of a serious job. A scammer treats questions as danger.

Sources: [DATCP-HI]

→ See Section 2, Step 18

A professional crew can work efficiently, but efficiency happens after planning. Be cautious of any offer that compresses estimate, contract, payment, mobilization, work, and final payment into the same surprise visit. Proper asphalt paving is scheduled around weather, plant availability, crew availability, and existing conditions. If a contractor says the job must happen immediately or not at all, ask who benefits from that timeline.

Sources: [BBB-2025] [DATCP-2023]

→ See Section 2, Step 19

Real asphalt operations plan material carefully because waste is expensive. There may be legitimate situations where a contractor has extra material, but that does not erase the need for a written scope, verified identity, insurance, payment terms, and proper construction. The question is never whether asphalt exists in a truck. It is whether the right contractor is using the right material on the right property under a written agreement.

Sources: [DATCP-2023] [BBB-2025]

→ See Section 2, Step 20

It depends on the work and the municipality. Local building inspection, engineering, or public works departments can explain whether a permit, right-of-way requirement, apron rule, or local license applies — especially when work touches a sidewalk, curb, driveway apron, culvert, or stormwater path. A contractor who says permits are never needed may be wrong. A contractor who shifts all permit responsibility to the homeowner may be hiding theirs.

Sources: [DATCP-HI]

→ See Section 2, Step 21

Agree in advance: no major home-improvement decision happens at the door without a call to a trusted person. Share warnings in church bulletins, senior community newsletters, subdivision pages, and local Facebook groups. Train front-desk staff at facilities not to sign or approve unsolicited work. Franklin Police's 2026 warning emphasized victims should report without shame.

Sources: [TMJ4-2026]

→ See Section 2, Step 22

Walk the project with the contractor. Compare the finished work to the written scope. Photograph it. Collect any applicable lien waivers, get a receipt, and save the warranty. DATCP specifically warns not to sign a completion certificate or make final payment until you're satisfied and all work matches the contract. Final payment is your leverage — once it's gone, so is most of your ability to require corrections.

Sources: [DATCP-HI] [DATCP-LIENS]

→ See Section 2, Steps 23–24

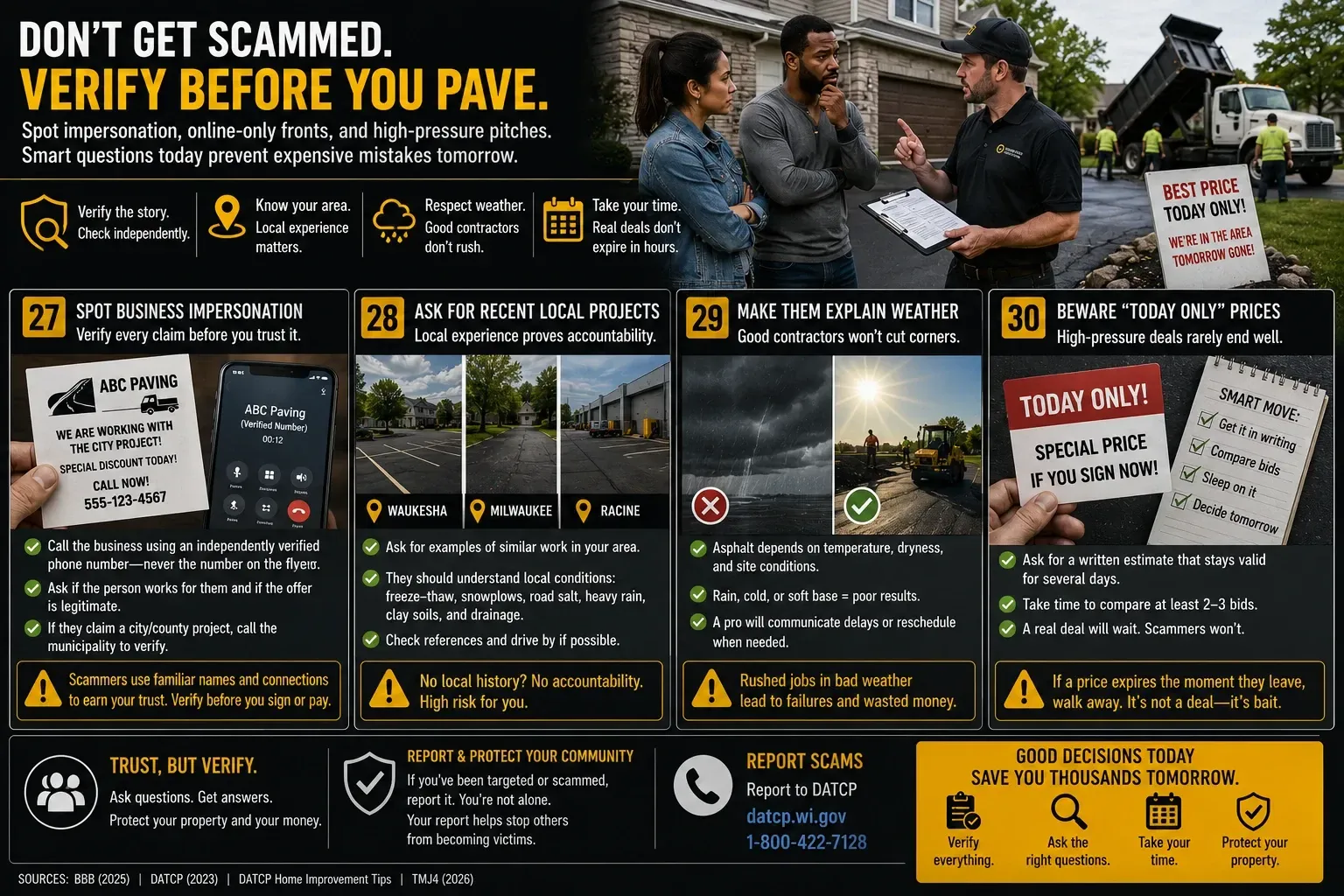

Some scammers claim a tie to a real local contractor, a known business owner's relative, a municipal project, or a nearby job. A polished website, copied logo, or fake review can look legitimate online. Always call the real business directly using a phone number found independently — not the one on the flyer — and confirm whether the person is theirs. BBB warns sham contact information often becomes obvious only after payment.

Sources: [BBB-2025]

→ See Section 2, Step 27

A legitimate contractor may offer real scheduling efficiencies or seasonal promotions. But a major property improvement shouldn't hang on a pressured decision made today. Ask for the written estimate to remain valid for a reasonable period. If the contractor says the price disappears the moment they leave the driveway, let it disappear. A good price that cannot survive one night of thought is a pressure tactic.

Sources: [BBB-2025] [DATCP-2023]

→ See Section 2, Step 30

Scammers isolate the decision-maker — they want one person, one moment, one payment. A household or business rule that no asphalt paving contract is signed without a second person reviewing it breaks that isolation. For homeowners, that's a spouse, adult child, or trusted neighbor. For businesses, it's the owner, property manager, or board. If the offer is real, the contractor can wait one phone call.

Sources: [BBB-2025]

→ See Section 2, Step 31

Section 3 — Building a Fraud-Resistant Market

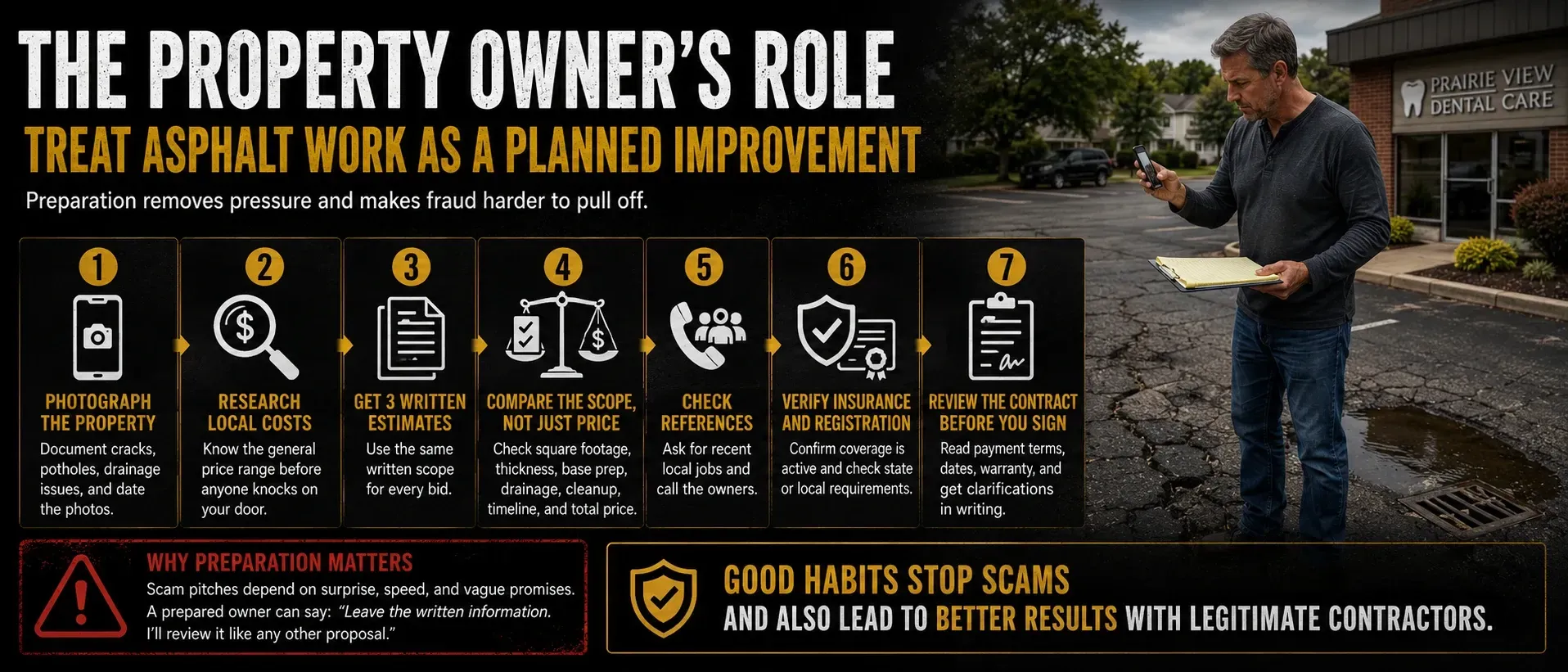

Treat asphalt work as a planned improvement, not a spontaneous purchase. Keep a record of current pavement condition, set a budget range, request multiple estimates, check references, ask for proof of insurance, and review written terms before signing. When the customer already has a process, a door-to-door scam loses most of its power — the answer becomes "leave your written information, it'll be reviewed like any other proposal."

Sources: [DATCP-HI]

→ See Section 3: Property owners

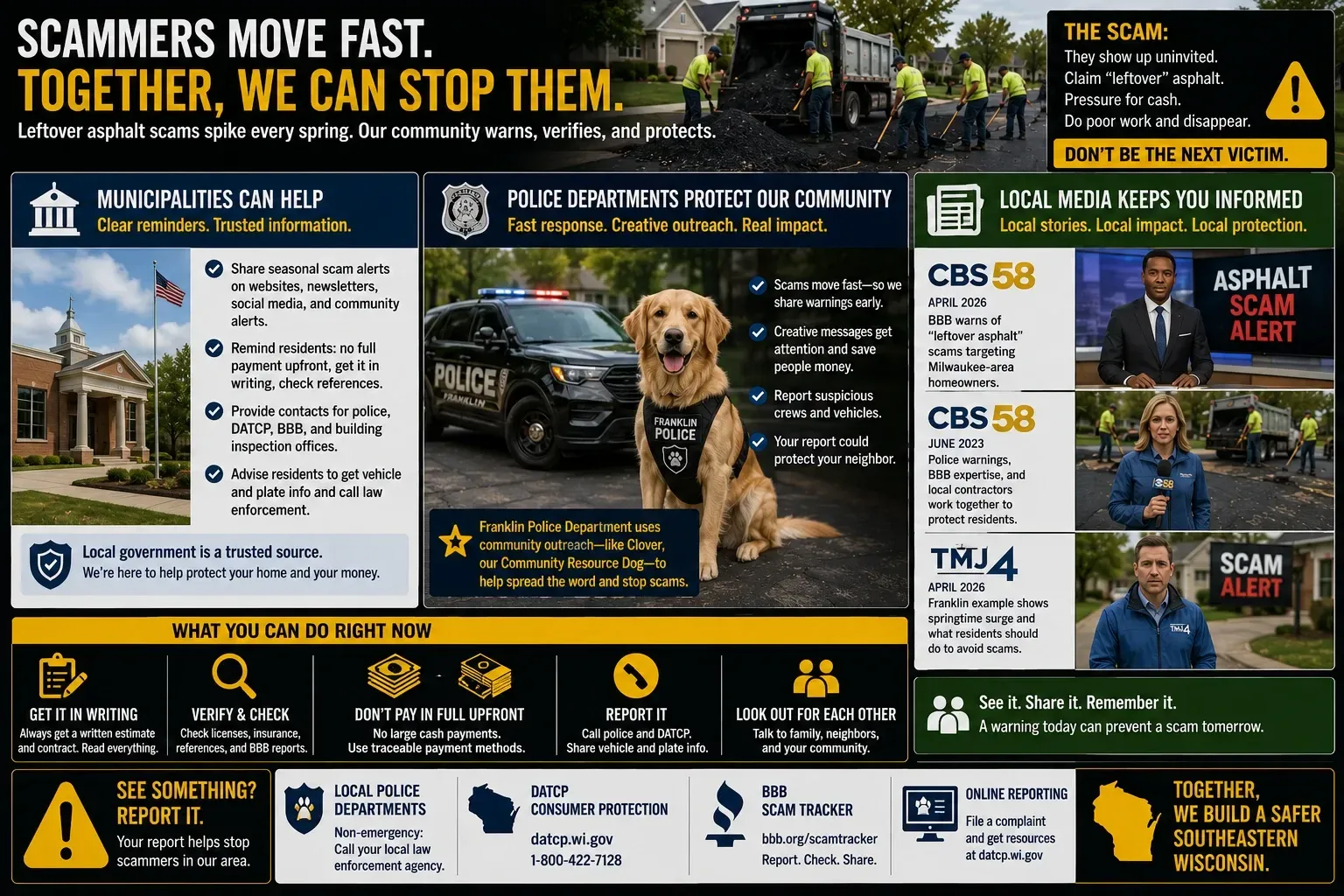

Neighbors can share factual warnings — time, location, vehicle, business name, phone — on community pages without spreading rumors. Avoid accusations that can't be supported, but do share public agency warnings and local news stories from DATCP, BBB, CBS 58, TMJ4, and police departments. The goal is to make sure the next homeowner recognizes the pitch before opening a checkbook.

Sources: [DATCP-2023] [CBS58-2026] [TMJ4-2026]

→ See Section 3: Families and neighborhoods

Adopt a written internal rule: no asphalt paving, sealcoating, striping, patching, or exterior repair work is approved through a walk-up offer. Front-desk and maintenance staff should request written information only, refuse immediate payment, and route every proposal through the authorized manager or board. HOAs should require at least two or three comparable bids, insurance certificates, references, and board approval before any payment.

Sources: [DATCP-2023] [DATCP-HI] [CBS58-2023]

→ See Section 3: Property managers, senior communities, and HOAs

Churches and nonprofits often have large lots, tight budgets, and volunteer boards. A traveling crew may pitch a discount that sounds like good stewardship. Small businesses face similar pressure when an owner is short on time and money. The protection is the same: written proposals, board or owner review, certificates of insurance, references, lien-waiver planning for larger projects, and no payment to an unverified crew.

Sources: [DATCP-HI] [BBB-2025] [DATCP-2023]

→ See Section 3: Churches, nonprofits, and small businesses

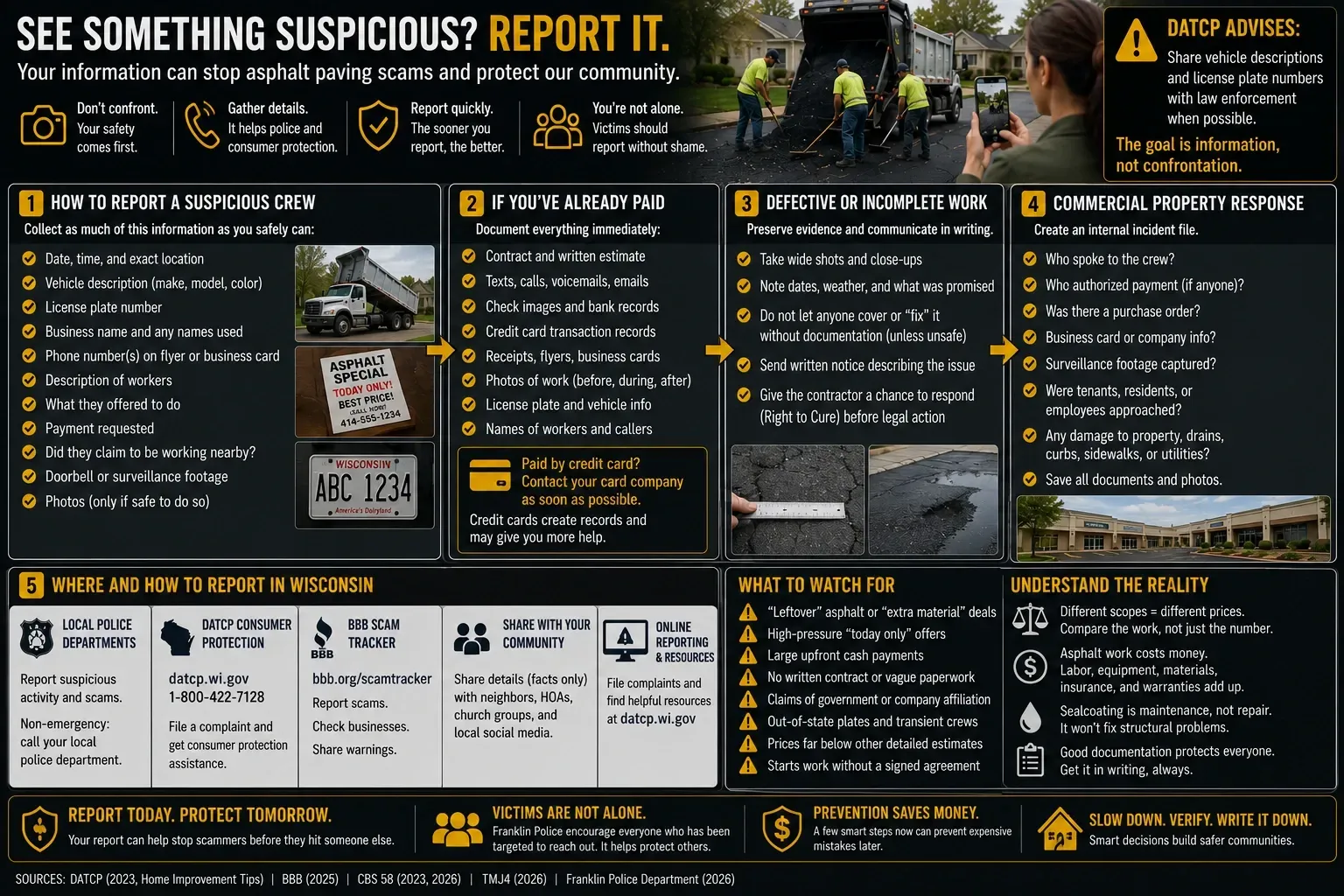

Capture date, time, location, vehicle description, license plate, names used, business name, phone number, and any flyer or card. Then report to local police and to DATCP at 1-800-422-7128. Doorbell camera clips help; photos are fine if it's safe to take them. The point isn't confrontation — it's giving investigators data to connect a pattern across communities.

Sources: [DATCP-2023]

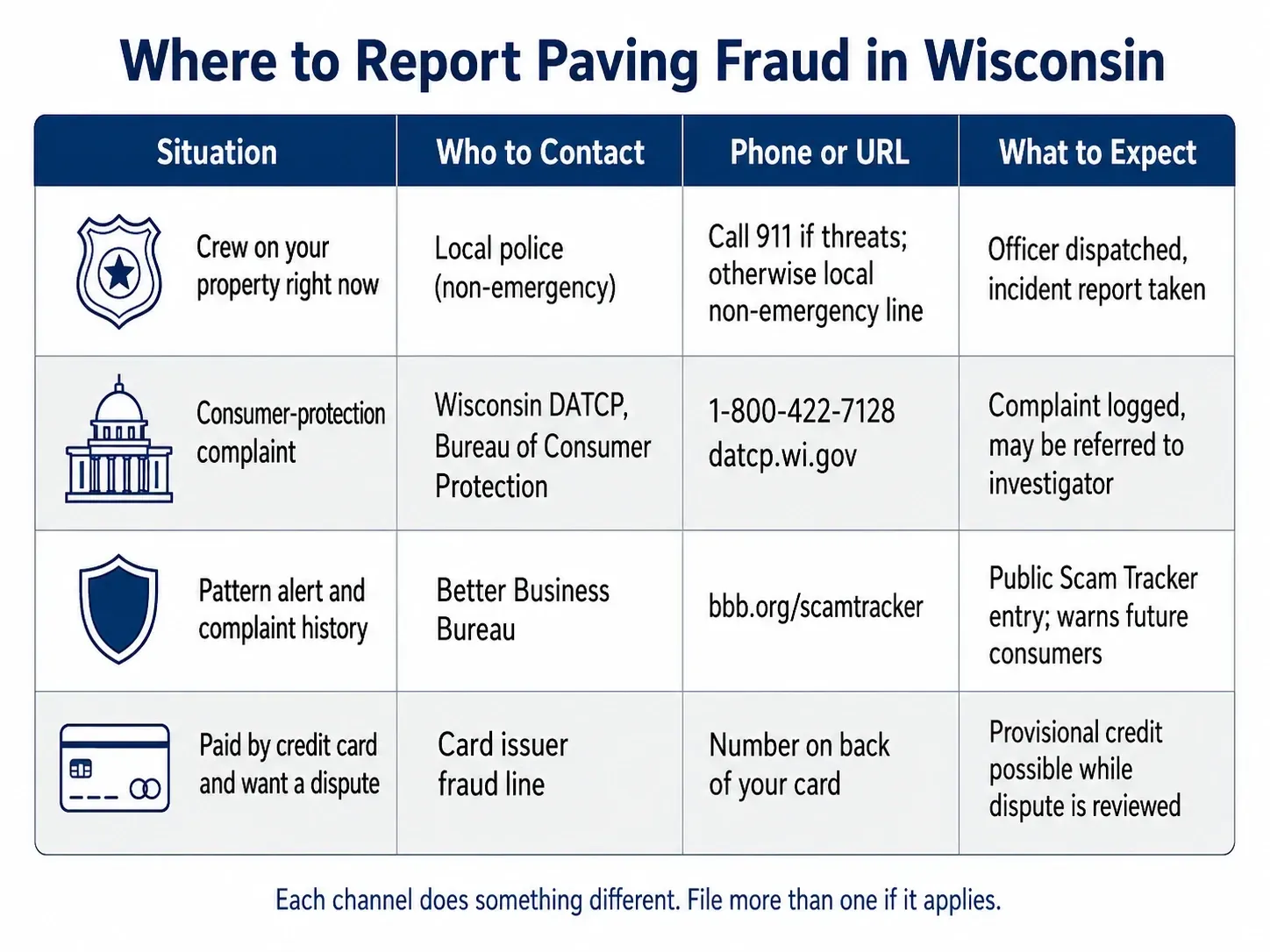

→ See Section 3: How to report a suspicious crew

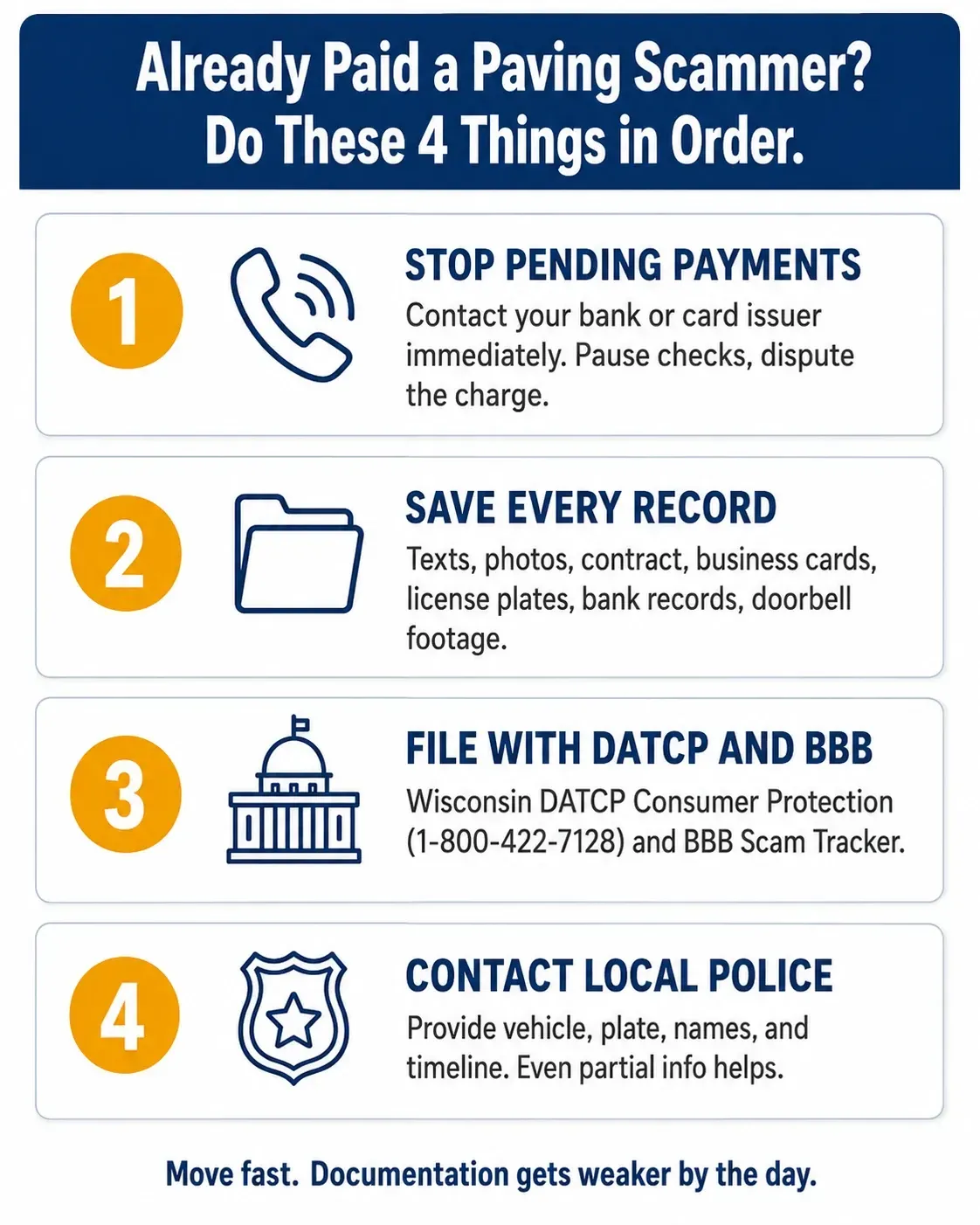

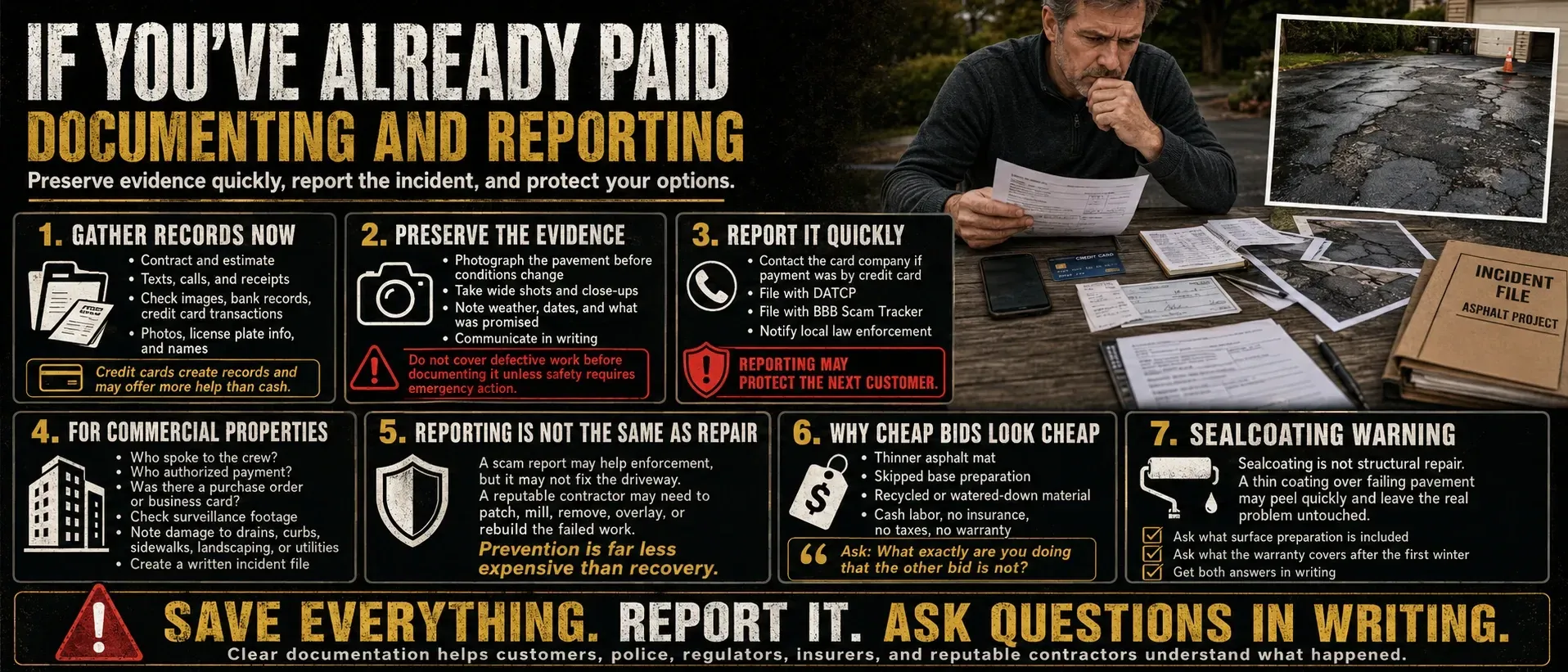

Gather every record immediately: contract, estimate, texts, calls, check images, bank statements, card transactions, receipts, photos, license plate, and names. If you paid by credit card, contact the card company quickly — CBS 58 and TMJ4 both report BBB advice favoring cards because they create documentation and a dispute path. File complaints with DATCP and BBB, and contact local law enforcement.

Sources: [CBS58-2026] [TMJ4-2026] [DATCP-HI]

→ See Section 3: If you've already paid

Freeze-thaw cycles, snowplows, and road salt expose weak work fast. Water that enters cracks or weak edges freezes, expands, and accelerates damage. Plows catch raised edges, thin overlays, and loose patches. A scammer's quick surface treatment may look fine in July and fail by March — by which point the crew is unreachable. Evaluate proposals on preparation, thickness, and drainage, not on how black the surface looks on day one.

Sources: [CBS58-2023] [DATCP-HI]

→ See Section 3: Wisconsin winters

For immediate safety, threats, trespassing, or unauthorized work in progress, call local law enforcement. For consumer-protection complaints, contact DATCP's Bureau of Consumer Protection at 1-800-422-7128 or datcp.wi.gov. For complaint history and Scam Tracker reports, file with BBB. If a credit card was used, contact the card issuer. Don't assume one report reaches the others.

Sources: [DATCP-2023] [BBB-2025]

→ See Section 3: Which agency handles what

Yes. A crew turned away at one home will try the next. If nobody reports the attempt, agencies may not see the pattern until after someone pays. DATCP's 2023 alert specifically asked consumers — including those who only encountered the pitch — to contact the Consumer Protection Hotline at 1-800-422-7128 and share vehicle and crew details. Reporting an attempted scam is early warning for the next house on the route.

Sources: [DATCP-2023]

→ See Section 3: Why every Wisconsin report matters

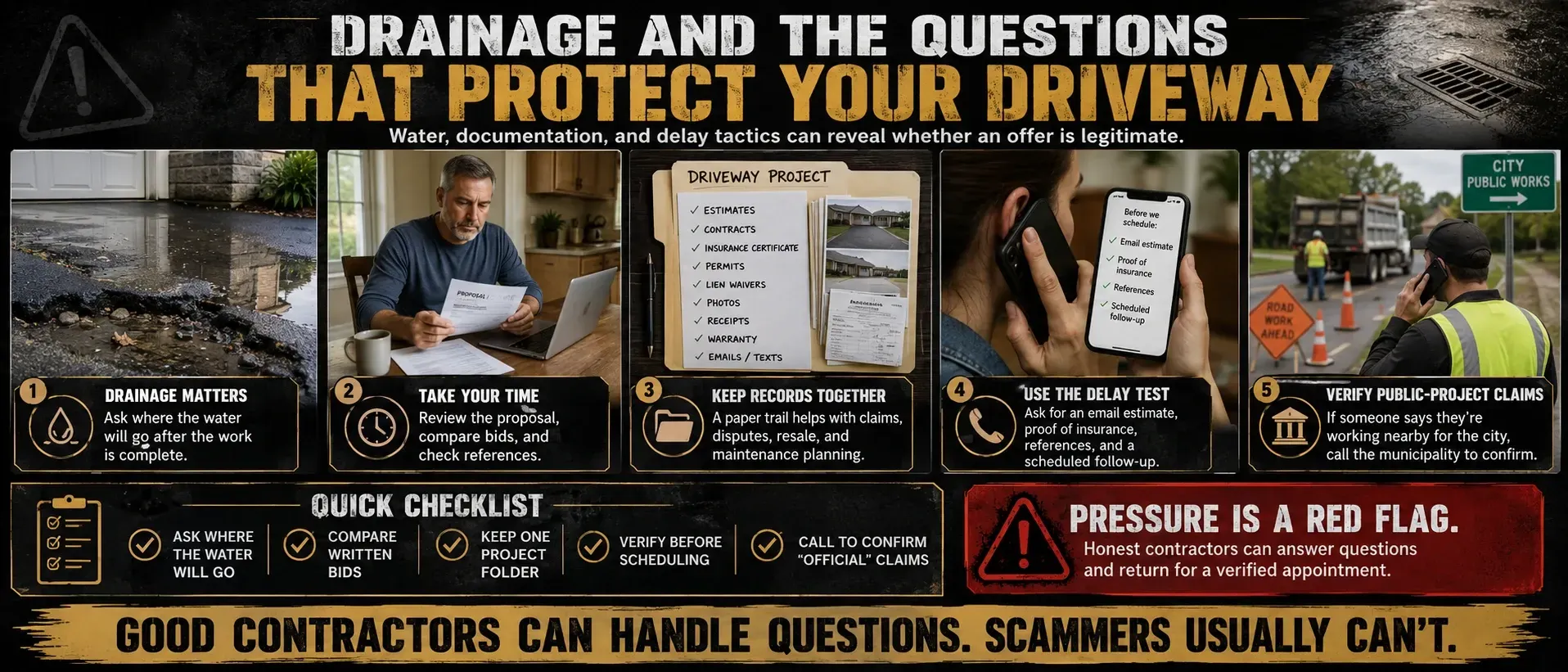

Every estimate should specify square footage, existing conditions, removal depth, base preparation, asphalt type, compacted thickness, transitions, drainage notes, edging, cleanup, schedule, warranty, and exclusions. Drainage, cleanup, edge restraint, and disposal of removed material are where fraud commonly hides. "I assumed it was included" is not an enforceable position. A clear scope makes comparison possible.

Sources: [DATCP-HI]

→ See Section 3: Drainage and the questions that protect your driveway

Section 4 — Cost, Maintenance, and Asphalt Driveway Questions

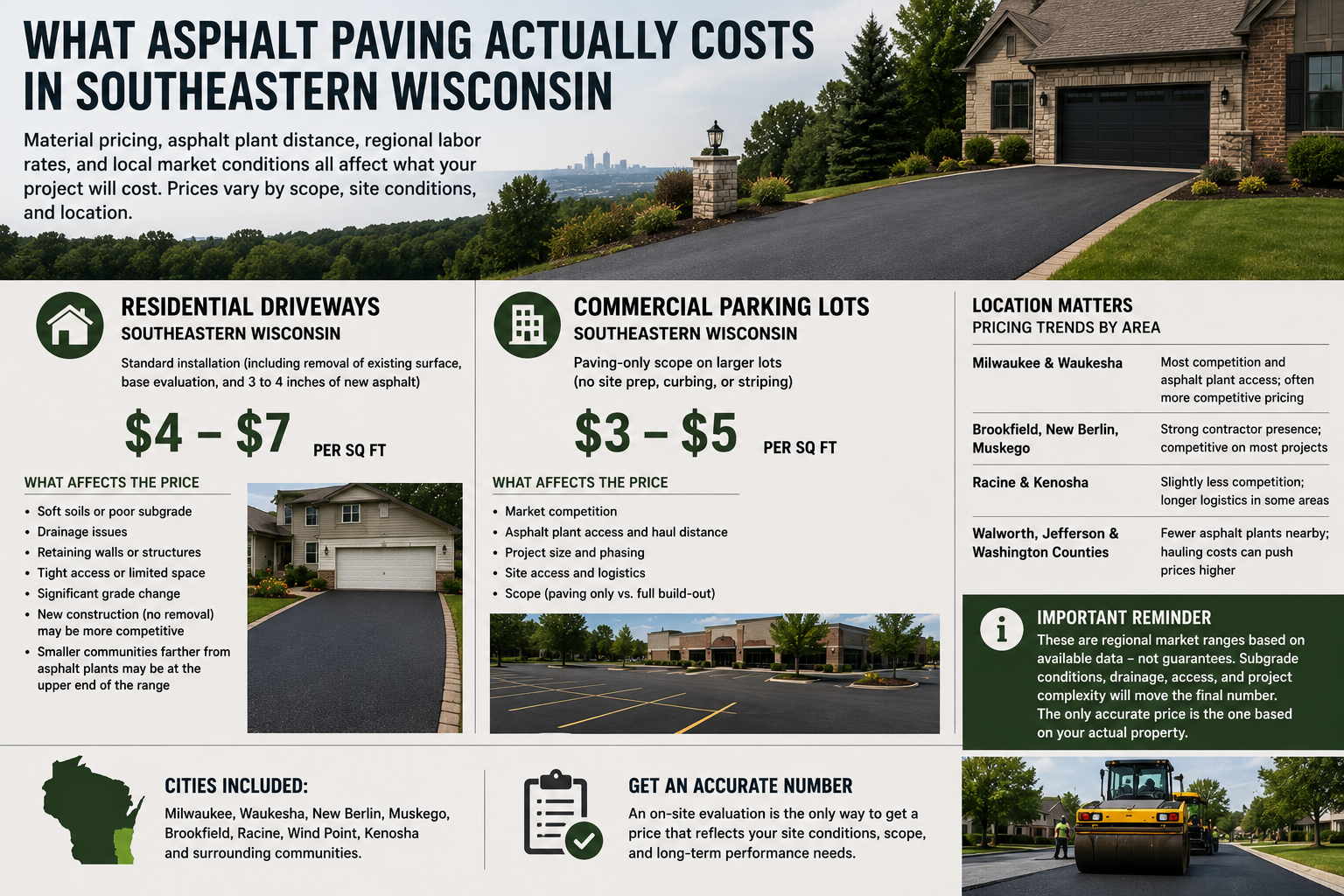

In southeastern Wisconsin, expect $3–$7 per square foot for a 2-inch asphalt overlay. Full remove-and-replace with proper base preparation runs $7–$12 per square foot. Final price depends on driveway size, existing base condition, drainage corrections, edge treatments, and disposal of old asphalt. A bid significantly below this range — half the price of competing estimates — is usually a different scope of work, not a better deal.

Sources: [CBS58-2023]

→ Pricing varies by site, year, and contractor. Get multiple written bids on the same scope. (See Section 2, Step 6.)

Both work in Wisconsin if installed correctly. Asphalt costs roughly half as much per square foot, is easier to repair, handles freeze-thaw and salt well when properly maintained, and can be paved in a single day. Concrete lasts longer (25–40 years vs 15–25 for asphalt), stays cleaner, and requires less maintenance, but costs more upfront and is harder to repair when it cracks. For most Wisconsin homeowners on a budget, asphalt is the practical choice when sealcoated regularly.

→ Both options have legitimate uses. The scam pattern in this report applies to both materials.

A properly built asphalt driveway in Wisconsin typically lasts 15 to 25 years. Lifespan depends on base preparation, asphalt thickness, drainage, compaction, and maintenance. Driveways that get sealcoated every 2 to 3 years, have proper edge support, and shed water rather than holding it can reach the upper end of that range. Driveways with poor base, thin layer, or trapped water often fail in 5 to 10 years — sometimes the first Wisconsin winter.

Sources: [CBS58-2023] [DATCP-HI]

→ See Section 3: Wisconsin winters — why bad work fails fast here

For a new asphalt driveway, wait 6 to 12 months for the surface to fully cure before the first sealcoat. After that, sealcoat every 2 to 3 years in Wisconsin's freeze-thaw climate. Sealcoating protects asphalt from UV damage, water penetration, and the chemicals in road salt and gasoline. It does NOT repair structural damage — sealcoating cracks does not fix them. If a contractor sells you sealcoating as a "fix" for a failing driveway, that is a scam pitch.

Sources: [DATCP-HI] [BBB-2025]

→ See Section 1: What's the difference between asphalt paving and sealcoating?

Late May through early October is the typical Wisconsin asphalt paving window. Asphalt requires ambient temperatures consistently above 50°F for proper compaction and bonding. Paving in cold weather or on wet ground can cause the mat to cool too fast, fail to compact properly, and develop early cracking. Reputable Wisconsin contractors will refuse to pave when conditions aren't right. A contractor willing to pave in November or after a hard rain is rushing the job.

Sources: [DATCP-HI]

→ See Section 2, Step 29: Weather and scheduling

For small surface patches and crack filling, yes. Cold-patch asphalt repair products from a home center can fix minor potholes and cracks if the underlying base is intact. For structural damage, alligator cracking covering large areas, edge failures, or repairs near drainage problems, professional work is the safer option. DIY patches over a failing base will fail again within a season. If multiple cracks reappear after patching, the underlying problem is the base, not the surface.

Sources: [DATCP-HI]

→ See Section 1: What a real asphalt paving contractor sounds like (drainage and base diagnosis)

Section 5 — Wisconsin Asphalt Paving Legal Questions

Generally no. Standard homeowner's insurance covers sudden, accidental damage from covered perils (fire, hail, vandalism). A bad paving job is a contract dispute, not a covered peril, so it typically falls outside coverage. Some policies include a contractor-fraud rider that may apply to outright criminal fraud. If you paid with a credit card, the card issuer's dispute process is often a faster recovery path than insurance. Check your policy and contact your agent.

Sources: [FTC-2024] [BBB-2025]

→ See Section 3: If you've already paid — documenting and reporting

There's no strict deadline for filing a consumer complaint with DATCP or the BBB — earlier is better. Evidence and contractor whereabouts deteriorate over time. For a civil lawsuit, Wisconsin's general statute of limitations for breach of contract is 6 years (Wis. Stat. § 893.43). Construction-defect actions may have additional procedural requirements under Wisconsin's Right to Cure law (Wis. Stat. § 895.07). Consult a Wisconsin attorney for case-specific guidance.

Sources: [DATCP-HI]

→ Report sooner rather than later. See Section 3: Where do you report asphalt paving fraud in Wisconsin?

Yes, generally. Wisconsin law allows homeowners to sue contractors for breach of contract, fraud, or defective work. However, Wisconsin's Right to Cure law (Wis. Stat. § 895.07) typically requires the homeowner to provide written notice of construction defects and give the contractor an opportunity to respond before filing suit. This is procedural and not optional. Consult a Wisconsin construction-law attorney before filing — process and evidence requirements matter.

Sources: [DATCP-HI]

→ Document everything in writing first. See Section 2, Step 25: Right to Cure

Wisconsin does not require a separate state license for asphalt paving contractors as such. The state credential most relevant to home improvement is the DSPS Dwelling Contractor Certification and Dwelling Contractor Qualifier Certification — required for contractors who pull building permits on one- and two-family homes. "Licensed" and "registered" get used loosely in advertising. Ask any contractor to specify exactly what credential they hold and verify it with DSPS or your municipality.

Sources: [DSPS-DC] [DSPS-DCQ] [DATCP-HI]

→ See Section 2, Step 5: Insurance, permits, and credentials

It depends on the scope and your municipality. Many residential driveway resurfacing jobs in Wisconsin don't require building permits, but work that touches the public right-of-way(apron, sidewalk, curb), affects drainage, or exceeds local thresholds typically does. Some municipalities require driveway permits regardless of scope. Always check with your local building inspection or public works department before authorizing work. A contractor who refuses to discuss permits may be hiding something.

Sources: [DATCP-HI]

→ See Section 2, Step 21: Use municipal resources when appropriate

Yes. Under Wisconsin's construction lien statute (Wis. Stat. Chapter 779), contractors, subcontractors, and material suppliers who improve real property can file a lien against the homeowner's property if they aren't paid. Lien waivers protect homeowners — Wis. Adm. Code ATCP 110.025 requires sellers to give notice that consumers may request written lien waivers at or before payment. Always request waivers from the prime contractor, subcontractors, and suppliers tied to each payment.

Sources: [WI-ATCP-110.025] [DATCP-LIENS] [DATCP-HI]

→ See Section 2, Step 10: Lien waivers

PCAA made this image for public use under the Creative Commons Attribution (CC BY) license.

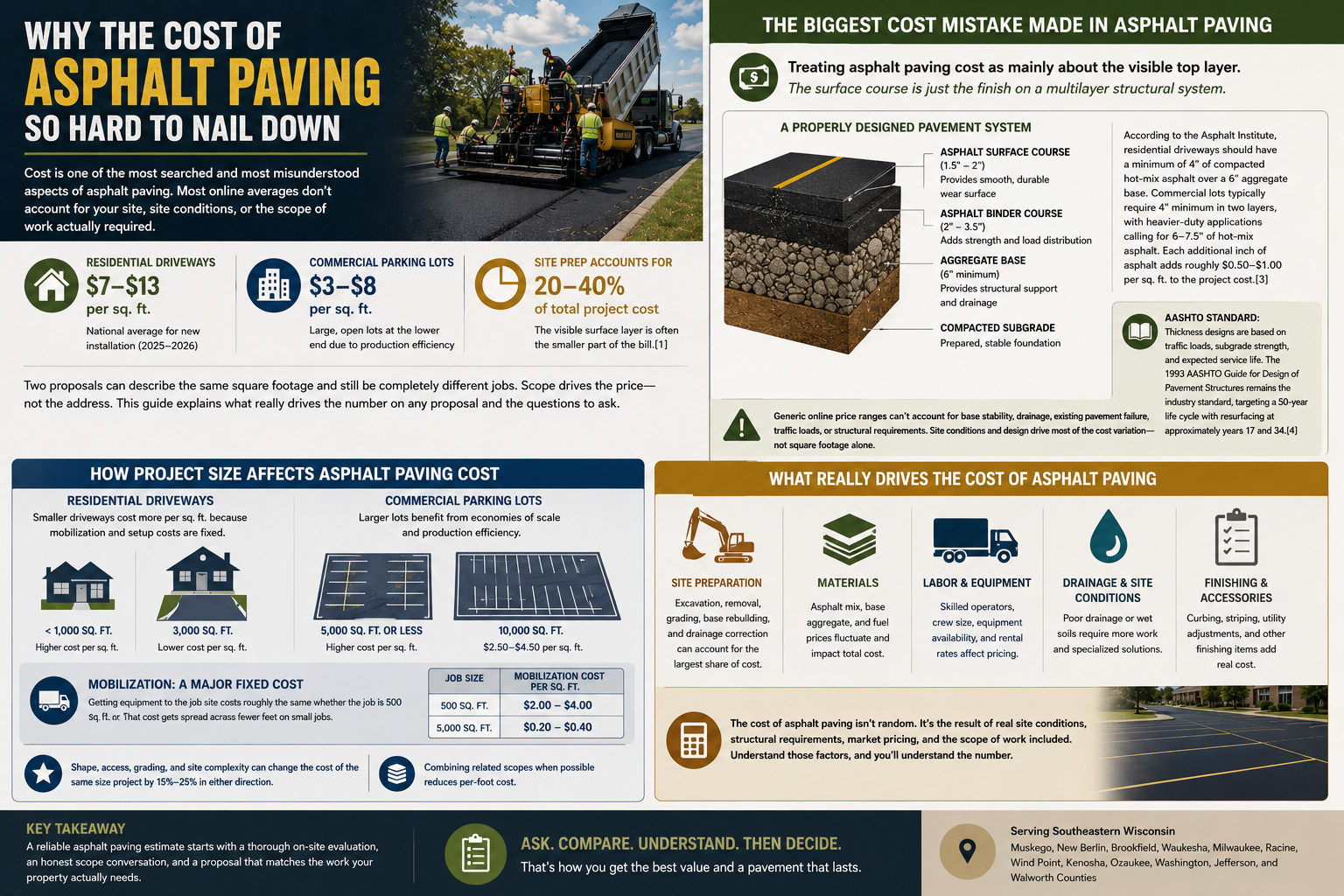

Why The Cost Asphalt Paving So Hard to Nail Down

Cost is one of the most searched and most misunderstood aspects of asphalt paving. That makes complete sense. Before committing to a project, property owners naturally want to know what it will cost. The problem is that most of what they find online is a national average that has almost nothing to do with their specific property, their site conditions, or the scope of work actually required.

According to current 2025–2026 market data, residential asphalt driveway installation runs $7 to $13 per square foot nationally for a new installation. Commercial parking lots typically fall between $3 and $8 per square foot, with large open lots often at the lower end of that range due to production efficiency. But these numbers are starting points, not quotes. They describe a range, not what your project will cost.

  • Industry data point: Site preparation alone accounts for 20 to 40 percent of total project cost, according to asphalt industry cost analysis. That means the visible surface layer you're paying for is often the smaller part of the bill.[1]

A lot of paving confusion starts because two proposals can describe the same square footage and still represent completely different jobs. One may assume minimal prep and a straightforward surface installation. The other may include excavation, removal of failed pavement, base rebuilding, drainage correction, and proper structural design for the traffic it will carry. Both can reference the same address. Both will price differently — and both can be correct, given their different scopes.

This guide is built on current market data, industry thickness standards, and real cost breakdowns. The goal is to give you enough factual grounding to understand exactly what is driving the number on any proposal you receive — and to ask the right questions before you sign anything.

PCAA made this image for public use under the Creative Commons Attribution (CC BY) license.

The Biggest Cost Mistake Made in Asphalt Paving

The single most common mistake owners make is treating asphalt paving cost as mainly a question about the visible top layer. It is not. The surface course is just the finish on top of a multilayer structural system. Price that system incorrectly, and the surface will fail regardless of how good the asphalt looks on day one.

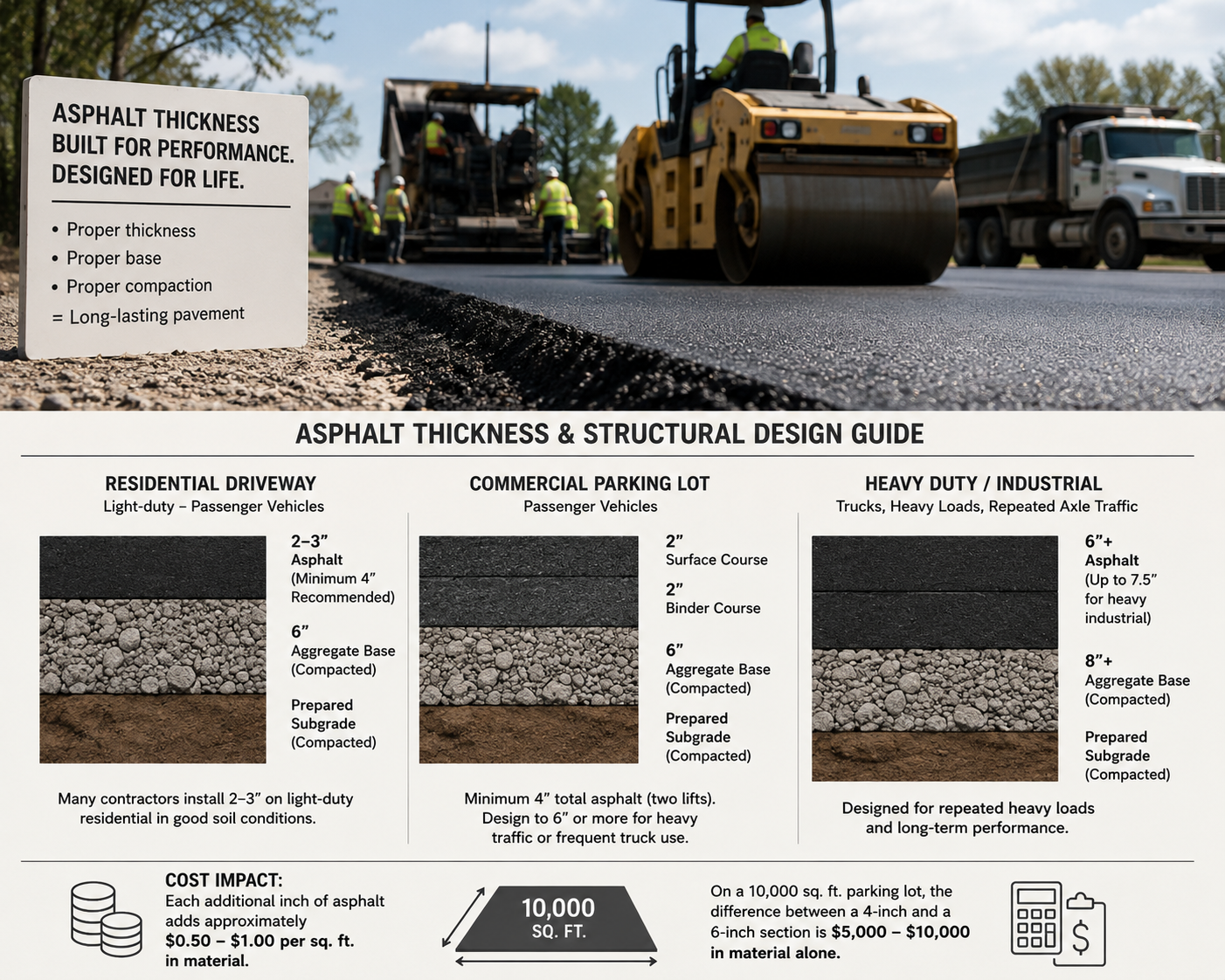

A properly designed pavement system has multiple components: a prepared subgrade, a compacted aggregate base, and one or more asphalt lifts. According to the Asphalt Institute, residential driveways should have a minimum of 4 inches of compacted hot-mix asphalt over a 6-inch aggregate base. Commercial parking lots handling delivery vehicles typically require 4 inches minimum installed in two layers, with heavier-duty applications calling for 6 to 7.5 inches of hot-mix asphalt. Each additional inch of asphalt adds roughly $0.50 to $1.00 per square foot to the project cost.[3]

  • AASHTO standard: Thickness designs for pavements are based on projected traffic loads, subgrade strength, and expected service life. The 1993 AASHTO Guide for Design of Pavement Structures remains the industry standard for thickness calculations, targeting a 50-year life cycle assuming resurfacing at approximately years 17 and 34.[4]

This is also why a generic online price range is often misleading. Those general ranges cannot account for whether the site is stable or unstable, whether it drains properly or pools water, whether an existing pavement has base failure beneath it, or what kind of traffic will use the surface. The site conditions and structural requirements are what drive the majority of the cost variation — not the square footage alone.

PCAA made this image for public use under the Creative Commons Attribution (CC BY) license.

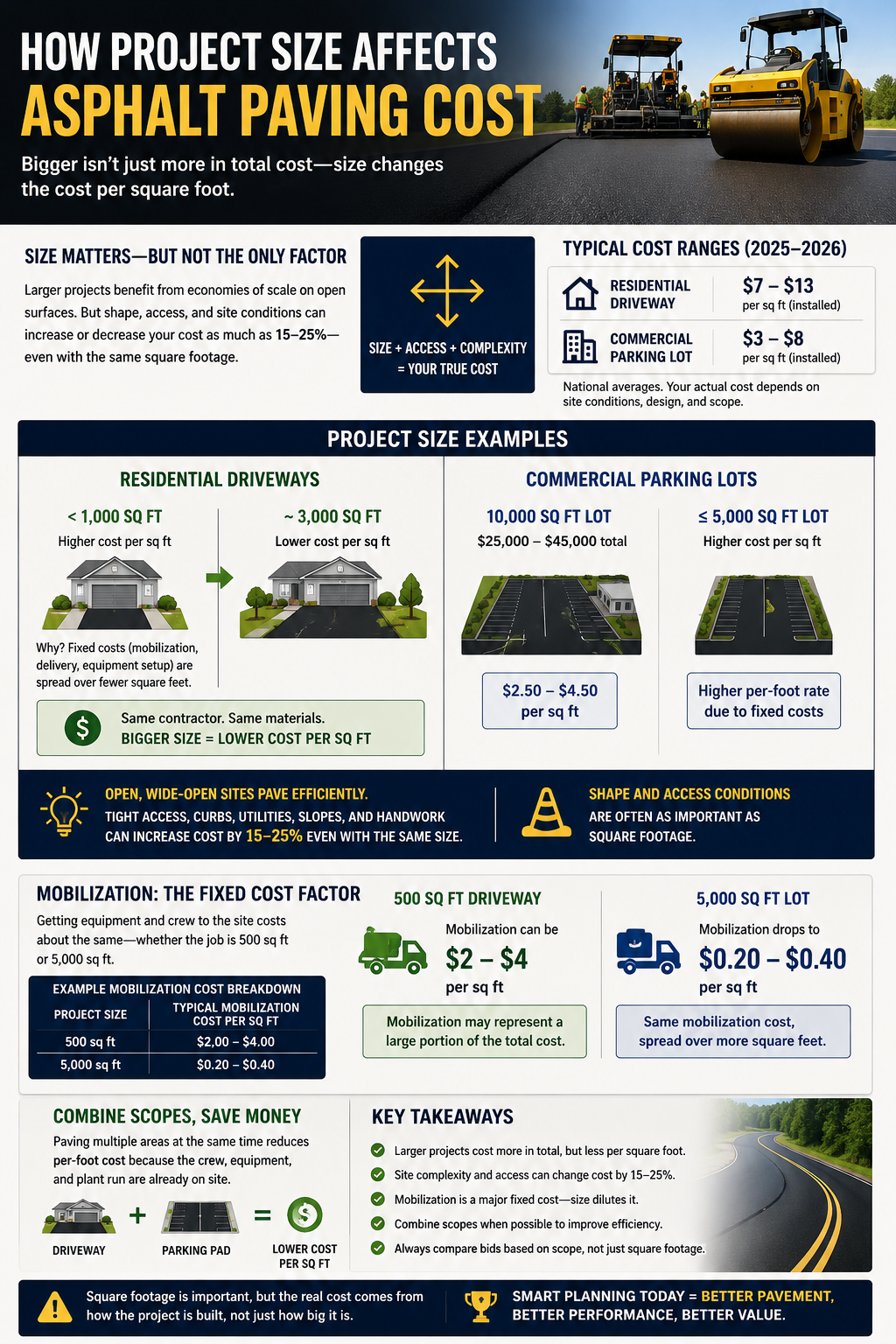

How Project Size Affects Asphalt Paving Cost

Square footage is obviously one of the biggest cost factors. Larger projects generally cost more in total, but they can also benefit from economies of scale — especially on open commercial surfaces where paving equipment can run efficiently without constant stopping, repositioning, and handwork.

For residential driveways, size has an outsized effect on per-square-foot cost because mobilization, material delivery, and equipment setup are largely fixed costs that get spread across fewer square feet. A small driveway under 1,000 square feet typically costs more per square foot than a 3,000-square-foot driveway from the same contractor using the same materials, simply because the overhead doesn't shrink proportionally. For commercial projects, a 10,000-square-foot parking lot typically runs $25,000 to $45,000 total — or roughly $2.50 to $4.50 per square foot — while a smaller lot of 5,000 square feet or less may carry a higher per-foot rate due to those same fixed costs.

But size alone never tells the full story. A wide-open 5,000-square-foot lot is a completely different job from a 5,000-square-foot surface with tight access, multiple elevation changes, utility structures, curbs, and required handwork. The open lot runs efficiently. The complex one does not. Shape and access conditions regularly move a job's cost as much as 15 to 25 percent in either direction, even when the square footage is identical.

Mobilization is one of the clearest illustrations of this fixed-cost dynamic. Getting equipment to the job site — paver, rollers, dump trucks, and crew — costs roughly the same whether the job is 500 square feet or 5,000. On a small job, the costs get spread across fewer feet, which is why many contractors set minimum job sizes or charge a mobilization fee on small projects. On a 500 square foot driveway, mobilization alone can represent $2 to $4 per square foot of the total cost. On a 5,000 square foot lot, that same mobilization cost drops to $0.20 to $0.40 per square foot. The asphalt itself did not get cheaper — the overhead got distributed more efficiently.

This is also why combining scopes when possible reduces per-foot cost. A property owner who paves a driveway and a small parking pad at the same time will almost always pay less per square foot than if they had done each project separately. The crew is already on site, the truck is already there, and the plant run is already scheduled. Scope consolidation is one of the most practical ways to improve cost efficiency without changing a single material specification.

PCAA made this image for public use under the Creative Commons Attribution (CC BY) license.

How Site Access and Layout Affect Asphalt Paving Cost

Site access is one of the cost drivers most owners do not think about until they see it priced. Asphalt is a hot-delivered material, which means trucks must be able to get in, dump, and get out efficiently. Paving equipment needs room to maneuver. Tight sites, narrow entrances, low-hanging trees, parked vehicles, proximity to buildings, grade changes, and phased access all slow things down — and slower operations cost more.

On residential properties, the most common access issues are narrow driveway entrances, garage alignment transitions, retaining walls, mature trees with surface roots, and curb cuts that require saw-cutting and patching. On commercial properties, the issues shift toward phased access to keep businesses open during paving, coordinating with tenant schedules, working around fuel islands, drive-throughs, or loading docks, and handling utility structures that need to be adjusted before or after paving.

Handwork is a direct reflection of access. Any area that equipment cannot reach efficiently must be finished by hand, which is slower, more labor-intensive, and more expensive per square foot. Contractors price these areas differently from open machine-paved sections, and that difference is a legitimate cost factor, not padding.

The cost difference between machine-paved and hand-finished areas is significant. A commercial paver running efficiently on open asphalt can place and finish several hundred tons per day. A crew finishing tight edges, corners, and transition areas by hand works at a fraction of that rate — and labor is priced accordingly. On complex residential driveways where a large portion of the surface requires handwork, the effective per-square-foot cost can run 20 to 40 percent higher than the equivalent open-surface area.

Truck access is equally important. Hot-mix asphalt arrives in dump trucks that must be able to back directly to the paver or dump into a material transfer vehicle. A site where trucks cannot back in efficiently forces the crew to hand-carry or wheelbarrow hot material, which slows production, increases labor cost, and risks temperature loss in the asphalt before it is compacted. Any site evaluation that does not account for truck access is missing a real cost variable.

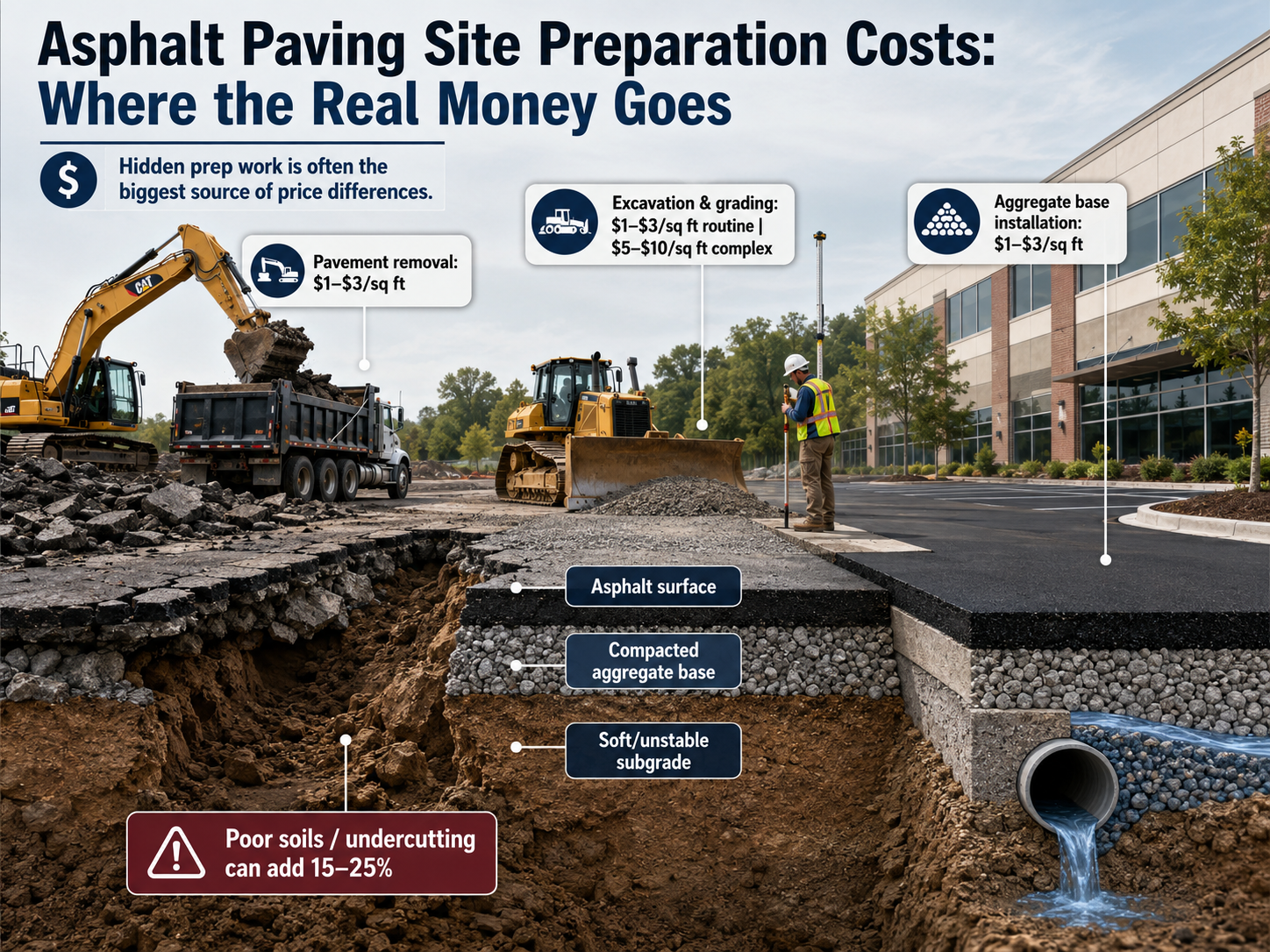

Asphalt Paving Site Preparation Costs: Where the Real Money Goes

If there is one category that creates the largest pricing differences between proposals, it is preparation. This is where the real structural work happens — and it is one of the clearest reasons why two estimates for the same address can be thousands of dollars apart.

Preparation costs vary enormously by site condition. On the low end, a site that already has a stable base and good drainage may require only minor grading adjustments before new asphalt is laid. On the high end, a site with widespread base failure, soft subgrade soils, poor drainage, or years of deferred maintenance may require full excavation, undercutting, base rebuilding, and drainage correction before any asphalt goes down.

Current 2025 data shows excavation and grading costs running $1 to $3 per square foot for routine work, and $5 to $10 per square foot on complex sites with significant grade correction or soft soil undercutting. Old pavement removal adds $1 to $3 per square foot for typical residential demolition, with costs rising for thicker commercial sections or sites with poor access. A standard aggregate base installation — the compacted gravel layer under the asphalt — runs approximately $1 to $3 per square foot for materials and compaction.

  • Industry data: Poor soil conditions requiring special base preparation or undercutting can increase total project cost by 15 to 25 percent compared to a standard site. That is a significant swing — and it is invisible in any quote that does not specify what prep work is included.

Removal of failed pavement is a real cost item that many low proposals simply omit or underestimate. Demolition and hauling require labor, equipment, and disposal fees — and if the removed material contains contaminants or old coal-tar sealant, disposal costs can increase further. Contractors who include thorough removal in their scope will price higher than those who propose an overlay on top of a failing structure. That difference reflects real construction value, not contractor preference.

The same is true for subgrade soil conditions. If the site contains soft, organic, or unstable soils, the contractor must undercut and replace that material with stable fill or an engineered base before paving. Skipping this step produces pavement that looks fine for 6 to 18 months and then begins to crack, settle, and fail from the bottom up — one of the most consistent causes of premature pavement failure.

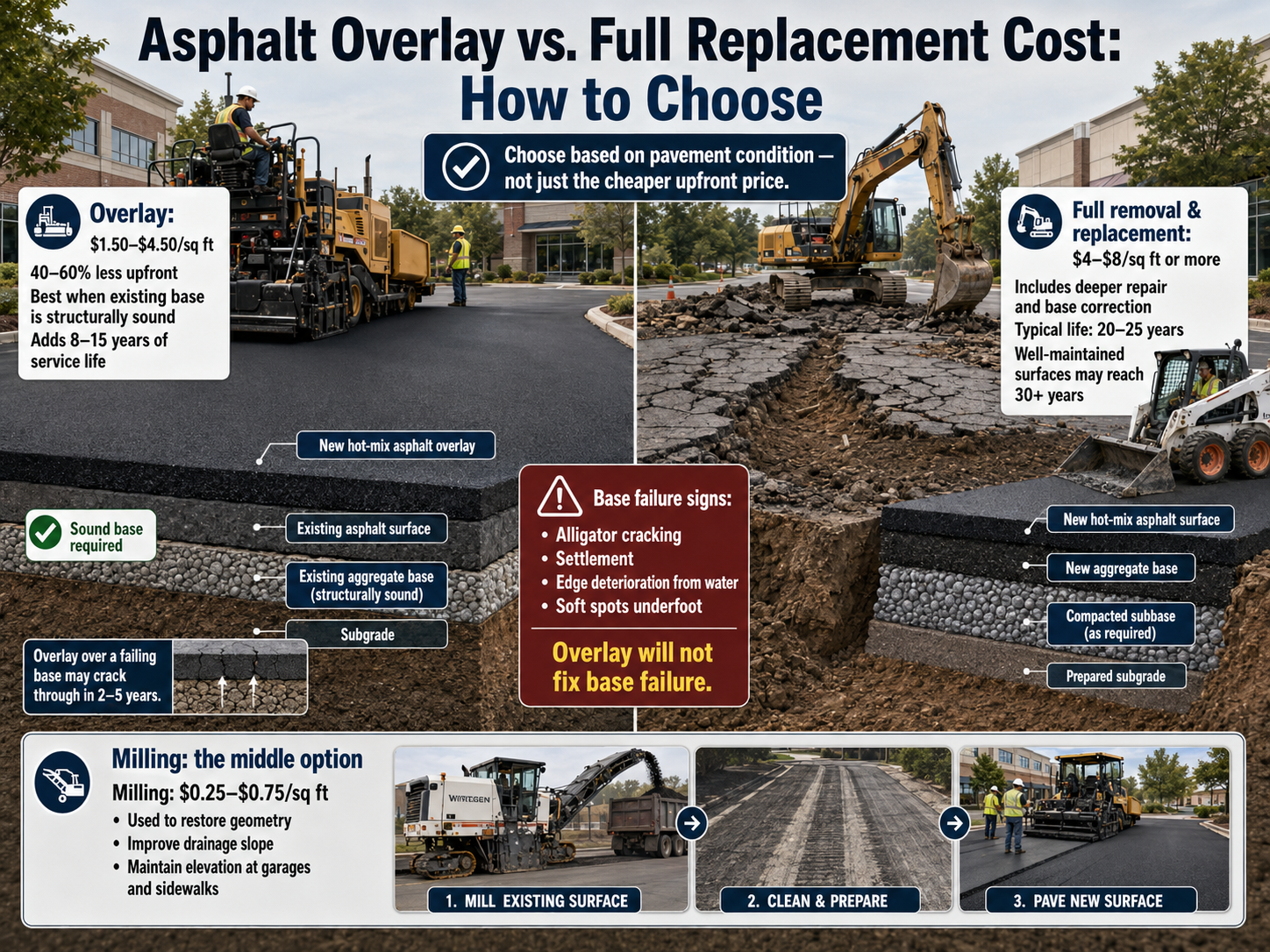

Asphalt Overlay vs. Full Replacement Cost: How to Choose

One of the most consequential cost decisions in asphalt paving is whether to resurface (overlay) an existing surface or to remove and replace it entirely. The right answer depends entirely on the condition of the existing structure — not on which option is cheaper upfront.

An asphalt overlay — placing a new layer of hot-mix asphalt over an existing surface — costs approximately $1.50 to $4.50 per square foot in current market conditions. Full removal and replacement runs $4 to $8 per square foot or more, depending on excavation depth and base work required. Overlays are 40 to 60 percent less expensive upfront, which makes them appealing. But they are only appropriate when the existing pavement structure is fundamentally sound.

According to industry data, an overlay on a structurally sound base adds 8 to 15 years of service life. A full replacement on a properly prepared base should last 20 to 25 years, with well-maintained surfaces reaching 30 years or more. An overlay placed over a failing base will reflectively crack through the new surface — typically within 2 to 5 years — as the underlying movement telegraphs upward.

  • Key distinction: If the existing pavement shows alligator (fatigue) cracking, significant settlement, edge deterioration from water infiltration, or soft spots underfoot, those are signs of base failure — not surface wear. An overlay will not fix base failure. Full replacement, including proper base correction, is the only durable solution.

Milling — grinding off the top layer of existing asphalt before applying new material — is a middle option used to restore surface geometry, improve drainage slope, or maintain elevation at garage transitions and sidewalks. Milling costs approximately $0.25 to $0.75 per square foot for the milling operation alone, with some contractors pricing it higher depending on depth and equipment mobilization.

Asphalt Thickness and Structural Design: How It Affects Cost

Asphalt thickness and the overall pavement section are not one-size-fits-all. They are engineering decisions based on the traffic the surface will carry, the strength of the underlying soils, and the expected service life. Building too thin for the actual conditions is one of the most common causes of premature failure.

For residential driveways serving standard passenger vehicles, the Asphalt Institute recommends a minimum of 4 inches of compacted hot-mix asphalt over a 6-inch compacted aggregate base. Many contractors install 2 to 3 inches on light-duty residential work, which may be adequate for low-traffic drives in good soil conditions — but thinner sections have less margin for error when soils shift, drainage is imperfect, or heavy vehicles occasionally access the surface.[3]

Commercial parking lots require more. The minimum for a standard passenger-vehicle lot is typically 4 inches of asphalt installed in two layers (a binder course and a surface course). Lots that receive delivery trucks, garbage trucks, or repeated heavy vehicle use should be designed to 6 inches or more. Heavy industrial pavements may call for 7.5 inches of full-depth hot-mix asphalt or a combination of asphalt and structural base designed for repeated axle loads.

Each additional inch of asphalt adds approximately $0.50 to $1.00 per square foot to the project cost in material alone. On a 10,000-square-foot parking lot, the difference between a 4-inch and a 6-inch section is $5,000 to $10,000 in material — a real number that explains why structural design assumptions affect price significantly between competing proposals.

Material Pricing, Oil Markets, and Why Asphalt Costs Shift

Asphalt is a petroleum-derived product — specifically, it is the heaviest residual fraction left after crude oil refining. That connection to oil markets means asphalt pricing is influenced by crude oil prices, refinery economics, and global supply dynamics, though the relationship is not perfectly linear or immediate.

Research published in the Transportation Research Record found that a 1 percent increase in crude oil prices corresponds to approximately a 0.7 percent increase in asphalt prices, with a time lag of roughly 3 months. This lag means that when oil prices spike — as they did in response to geopolitical disruptions in early 2025 — asphalt costs may not fully reflect that increase until the following quarter.[5]

As of late 2025, liquid asphalt (bitumen) prices in North America were running approximately $0.64 per kilogram, or roughly $580 to $640 per metric ton. Refined hot-mix asphalt — the finished product delivered to job sites — was priced in the $40 to $80 per ton range depending on mix type, plant, and region. Transportation from the plant adds directly to that cost, and for projects farther from a plant, hauling can represent 20 to 30 percent of total material cost.[6]

  • Important note: Asphalt is a time-sensitive material. It must be placed and compacted while still hot enough to bond properly. Once it leaves the plant, the clock is running. Distance from the plant is not just a fuel cost — it directly affects material quality at the time of placement and limits how far any given plant can efficiently serve.

Fuel prices amplify this effect. When diesel prices rise, hauling costs increase even if raw asphalt material prices hold steady. Mobilization — getting equipment to and from the site — is also a fuel-dependent cost. These factors combine to make asphalt paving slightly more expensive in years with elevated fuel prices, and they explain some of the seasonal variation in pricing that contractors and owners both observe.

Recycled Asphalt and RAP: What It Is and When It Makes Sense

Recycled asphalt pavement (RAP) is exactly what it sounds like: old asphalt that has been milled up, processed, and reintroduced into new hot-mix as a partial replacement for virgin aggregate and binder. According to the Federal Highway Administration (FHWA), RAP is the most recycled material in the United States by volume, with the average hot-mix asphalt plant in the country incorporating roughly 12% RAP into every batch.

Independent research—and field performance data tracked by state DOTs—consistently show that mixes containing up to 30% RAP perform on par with 100% virgin HMA for standard roadway and parking-lot applications when properly engineered.[2]

The cost difference is material. Virgin HMA aggregate and liquid asphalt binder are tied directly to crude oil prices; RAP is not. Material costs for processed recycled asphalt run roughly $10–$20 per ton, compared to $50–$80+ per ton for virgin HMA mix, and those savings flow through to the installed price. A recycled asphalt driveway or parking area using a high-RAP mix typically runs $3–$8 per square foot installed, versus $7–$13 per square foot for new HMA. That gap widens further when crude oil spikes. For budget-sensitive projects where aesthetics matter less than function—secondary access roads, equipment staging areas, overflow parking—RAP is a legitimate engineering choice, not a cut corner.

That said, RAP is not appropriate everywhere. High-RAP mixes require mix design expertise to prevent brittleness from aged binder, and loose crushed asphalt millings are not the same as a properly engineered bound HMA surface—they will rut and ravel under heavy or concentrated loads. For driveways, parking lots, and roadways that will see regular vehicle traffic, a qualified mix design with verified RAP content is essential. Ask your contractor for the mix design specification and the plant's RAP percentage; a legitimate paving operation will have this documentation on hand.

Drainage: The Cost Factor That Protects Everything Else

Water is the primary enemy of asphalt pavement. Poor drainage causes edge deterioration, base saturation, frost heave, and accelerated cracking. A paved surface that looks good but traps water will begin failing early — typically from the bottom up as saturated base material loses load-bearing capacity.

Drainage correction can take several forms, each with its own cost. Basic grading work to correct low spots and improve slope is often part of standard site prep. More significant drainage work — adding or rebuilding catch basins, installing perimeter edge drains, correcting cross slopes, or integrating with existing storm systems — adds real cost but also provides real value.

Current data shows catch basin installation running $1,000 to $4,000 per unit, depending on size, depth, and material. Catch basin repair or adjustment — often required when paving changes the surrounding grade — runs $2,500 to $5,000 per unit for significant repair. Linear drainage systems cost approximately $10 to $25 per linear foot installed. These are not optional costs on sites that need them — they are infrastructure investments that protect the pavement above.

Owners sometimes compare a lower proposal that excludes drainage correction to a higher proposal that includes it and assume the lower contractor is simply cheaper. In many cases, the lower contractor is deferring a drainage problem that will cost more to address once the pavement is in place. Fixing drainage under existing asphalt almost always costs significantly more than addressing it during construction.

Pavement slope is one of the most underappreciated drainage tools. Industry standards recommend a minimum cross-slope of 1.5 to 2 percent on paved surfaces to move water off the surface quickly. A properly graded surface sheds water in seconds. A flat or negatively sloped surface holds it. In Wisconsin's climate, standing water on or at the edges of pavement freezes, expands, and works into any crack or joint — accelerating deterioration that might otherwise take years to develop. Getting the grade right during construction costs nothing extra when it is designed in from the start. Correcting it after the fact means removing and repouring asphalt.

Edge conditions deserve particular attention. Pavement edges that are not supported by a curb, concrete header, or properly compacted shoulder are vulnerable to water infiltration and edge cracking. Water that gets underneath an unsupported edge saturates the base material, which loses strength when wet and begins to shift under load. Protecting edges — whether through concrete curbing, compacted aggregate shoulders, or proper grading — is a drainage measure as much as it is a finishing detail.

Asphalt Paving Details: Edges, Transitions, and Striping Costs

Not all of the cost difference comes from heavy structural work. Detail work matters too — and it often separates a pavement that looks professionally finished from one that looks like a flat pour.

Edge work includes the treated, compacted edges of the asphalt surface — how they tie into curbs, sidewalks, landscaping, or open grade. On residential driveways, transitions to the garage apron, the street connection, and any sidewalk or curb cut require precise grade matching and may need saw-cutting or hand-formed edging. Commercial properties often include curb and gutter work, island borders, entrance transitions, and ADA compliance requirements — all of which add scope and cost.

Striping is an additional cost category for commercial and multi-family properties. Current market data puts standard parking lot striping at $0.20 to $1.00 per linear foot for paint and $0.60 to $2.00 per linear foot for thermoplastic markings (which last significantly longer). Per-space pricing typically runs $5 to $20, depending on stall size and layout complexity. ADA-compliant accessible spaces require additional marking and signage and are priced accordingly.

Utility adjustments — raising or lowering manhole covers, valve boxes, and drain frames to match new pavement grades — are often overlooked in early cost conversations. Each adjustment typically adds $200 to $500 per structure, and a commercial lot with multiple utility structures can see this become a meaningful line item.

Concrete curbing is a frequent companion to commercial asphalt paving and carries its own cost line. Machine-formed concrete curb and gutter typically runs $15 to $30 per linear foot installed, while hand-formed curb in tight areas or with complex geometry runs higher. Islands, wheel stops, speed humps, and bollards are additional line items that belong in a commercial scope comparison. A proposal that excludes these items will look cheaper on paper, but will require them to be added separately before the lot is functional.

For residential driveways, the garage apron transition is one of the most technically demanding details in the job. The new asphalt must meet the existing concrete at exactly the right elevation — too high, and it creates a trip hazard and blocks drainage; too low, and it creates a gap that collects water and debris. In Wisconsin's freeze-thaw environment, a poorly executed garage transition will separate and heave within one or two winters. This detail is not a cosmetic concern — it is a structural and drainage junction that needs to be set correctly from the start.

Residential vs. Commercial Paving: Where the Numbers Differ

Residential and commercial paving share the same fundamental process but diverge on almost every cost variable. Understanding those differences helps owners in both categories interpret proposals more accurately.

Residential driveways are typically smaller, tighter, and more labor-intensive per square foot. The national average for a new residential driveway in 2025–2026 runs $7 to $13 per square foot installed — a range that reflects the wide variation in driveway size, site access, prep requirements, and regional labor markets. In communities like Brookfield, New Berlin, Muskego, and Wind Point, where lot sizes vary widely and access conditions range from straightforward to highly complex, individual site conditions routinely move a project's cost well outside any published average.

Commercial parking lots benefit from scale and open production but come with their own cost layers. A standard commercial lot in the 10,000 to 50,000 square foot range often prices between $2.50 and $4.50 per square foot for the paving itself — but site prep, drainage, concrete curbing, striping, lighting coordination, ADA compliance, and permit requirements can push the all-in project cost significantly higher. A complete commercial lot build-out, including all site work, is a different animal from a paving-only scope.

  • Data point: About 94 percent of American roads and 85 percent of parking lots and driveways are paved with asphalt, making it the dominant surface material in the U.S. Its popularity reflects a combination of lower initial cost, repairability, and compatibility with cold-climate freeze-thaw cycles — all relevant to Wisconsin conditions.[1]

One cost category that catches commercial property owners off guard is ADA compliance. The Americans with Disabilities Act requires accessible parking spaces, access aisles, curb ramps, and connecting accessible routes that meet specific slope, width, and surface requirements. On a new commercial lot or a significant resurfacing project that triggers ADA review, compliance work can add $3,000 to $8,000 or more, depending on the number of accessible spaces required, the grade of the existing site, and the complexity of the accessible route. Factoring ADA requirements into the initial design is far less expensive than retrofitting for compliance after the fact.

Asphalt vs. Concrete: An Honest Cost Comparison

Asphalt and concrete are the two most common choices for driveways and parking lots, and the cost comparison between them deserves an honest, data-based treatment rather than a sales pitch for either.

On initial installation cost, asphalt is clearly less expensive. For standard residential driveways and parking lots, current data puts asphalt at $7 to $13 per square foot installed, with specialized mixes such as permeable or polymer-modified asphalt reaching $15 per square foot. Concrete runs $8 to $20 per square foot. For comparable standard surfaces, asphalt is roughly half the upfront cost of concrete. That difference is real and significant for owners managing project budgets.

On lifespan, the picture is more nuanced. A properly installed asphalt surface averages 15 to 20 years before major repair or replacement, with well-maintained surfaces reaching 25 to 30 years. Concrete averages 27.5 years with the potential to reach 40 years with good maintenance. That difference is meaningful over the long term.[1][10]

On the total cost of ownership, the comparison depends heavily on maintenance. Asphalt requires sealcoating every 2 to 5 years at $0.15 to $0.25 per square foot for commercial surfaces, plus periodic crack filling and spot repair. Over a 20-year lifespan, total maintenance costs typically run $2,000 to $4,000 for a standard driveway. Concrete requires less frequent sealing but is more expensive to repair when it does crack or settle, and is significantly more difficult to patch invisibly. Some analyses conclude that concrete's higher upfront cost is recouped by approximately year 15 — though this depends on local labor rates, climate, and usage.[1]

In Wisconsin's freeze-thaw climate, asphalt has a practical advantage: it flexes slightly through temperature cycles rather than cracking rigidly the way concrete does. Concrete is more vulnerable to deicing salt damage and can spall under repeated freeze-thaw exposure. Asphalt is easier to repair section by section. For high-traffic commercial surfaces expecting 20-plus years of heavy use, concrete can make economic sense over the full ownership period. For residential driveways with a 15 to 20-year horizon, asphalt almost always wins on total cost

Asphalt vs. Pavers and Brick: The Premium Surface Option

Concrete unit pavers—clay brick, concrete block, natural stone—represent the premium tier of paved surfaces and carry installed costs to match. Professionally installed pavers run $10–$45 per square foot, depending on material, pattern complexity, and site preparation required. Natural stone (bluestone, travertine, granite) reaches the high end of that range; standard concrete pavers start around $10–$15 installed. By comparison, asphalt runs $7–$13 per square foot for residential, 40 to 60 percent less upfront on equivalent square footage. On a 2,000-square-foot residential driveway, that difference translates to $6,000–$64,000 in installed cost depending on material choice.

The long-term calculus is more nuanced. Properly installed unit pavers have documented lifespans of 25–50 years with routine joint sand replenishment and periodic releveling. They are also individually replaceable: when a utility trench cuts through a paver surface, the affected units come up and go back down cleanly with no visible patch line. Real estate economists have attributed 5–10 percent property value increases to high-quality paver installations in residential settings—a premium with no reliable equivalent for asphalt or standard concrete. For homeowners in markets where curb appeal drives valuations and planning a sale within a decade, the math can favor pavers. For commercial operators, fleet-heavy properties, or anyone maximizing paved area on a budget, it rarely does.

Pavers are also structurally impractical for most commercial paving applications. Large surface areas require extensive, precisely graded aggregate base work to prevent differential settlement—the primary failure mode of unit paver installations is individual units rocking or sinking as base material migrates under traffic. Installation labor is intensive and highly skilled, which is why contractor availability for large-scale paver work is limited in most Midwest markets. For any surface exceeding 5,000–10,000 square feet, asphalt remains the dominant choice for cost, installation speed, and structural performance under heavy repetitive loads. Pavers belong in the decision matrix for residential driveways, walkways, patios, and entrance features where aesthetics and long-term curb appeal justify the premium.

Seasonal Timing and Its Effect on Asphalt Paving Cost

Asphalt paving is a seasonal business in Wisconsin and throughout the Midwest. Hot-mix asphalt requires ambient temperatures above approximately 50°F during placement and compaction, which limits the practical paving season to roughly late April through October, depending on the year. Plant shutdowns, reduced availability, and end-of-season demand spikes all affect scheduling and, in some cases, pricing.

Booking early in the season — spring through early summer — typically gives owners the widest contractor availability and the most scheduling flexibility. Late-season work (September and October) can be excellent from a material standpoint, as cooler ambient temperatures actually slow the cooling of hot-mix asphalt slightly, giving crews more working time — but contractor schedules are often compressed, and weather windows can close quickly.

Fuel prices, steel prices (relevant to equipment and curbing), and aggregate costs all fluctuate through the year and across years. When diesel prices rise, mobilization and hauling costs increase even if asphalt material prices hold steady. This is one reason identical projects can price differently from year to year, and why a quote from two years ago is not a reliable benchmark for what a project costs today.

Temperature is not just a scheduling factor — it is a material quality factor. Hot-mix asphalt leaves the plant at approximately 275 to 325 degrees Fahrenheit and must be placed and compacted before it drops below roughly 175 to 185 degrees, depending on the mix design. Once it cools below that threshold, proper compaction becomes impossible, and the pavement will be underdense, which shortens its service life. In Wisconsin, ambient temperatures below 50°F accelerate cooling significantly — which is why responsible contractors will not pave when ground or air temperatures are too low, even if the project calendar is tight.[3]

Demand patterns in the region follow a predictable curve. Work booked in early spring — April through May — typically has the widest contractor availability and the longest lead time to accommodate large commercial projects. June through August is peak season: plants are running at full capacity, crews are fully deployed, and scheduling windows compress. September and October offer a secondary window with quality conditions but limited availability. Property owners who wait until late summer to schedule spring projects routinely find themselves pushed into the following season. Planning by three to six months is not excessive for commercial projects in the Milwaukee and Waukesha markets.

How Long Does Asphalt Paving Take: Timelines from Start to Traffic

Project duration depends on scope, site conditions, and crew size—but the industry benchmarks are well-established. A standard residential driveway (600–1,500 square feet) with minimal site prep runs one to two days from equipment arrival to final rollout. A mid-size commercial parking lot (10,000–30,000 square feet) is typically a two-to-four-day job. Large-scale commercial paving—shopping centers, distribution facilities, multi-phase parking structures—can run one to two weeks or longer, depending on phasing requirements that keep portions of the lot accessible during construction. Rain delays mid-pour require halting work entirely, as wet subgrade or active precipitation will contaminate the mix.

Return-to-use timelines are where owners most often get into trouble. New asphalt can bear foot traffic in 24–48 hours once surface temperatures drop below 100°F—typically the following morning in summer conditions. Light passenger vehicles can generally return in 72 hours. Heavy vehicles—loaded delivery trucks, dumpsters, construction equipment—should stay off new pavement for 7–14 days minimum, and longer in hot weather when the surface remains pliable. Full structural cure, during which the asphalt binder achieves its design strength through oxidation and compaction creep, takes 6–12 months. This is why reputable contractors recommend waiting a full season before applying sealcoat: sealing too early traps volatiles in the binder and can extend softness rather than protect the surface.

Planning lead times matter as much as construction duration. During peak season in the upper Midwest—typically May through September—established paving crews book 4–8 weeks out for residential work and 6–12 weeks out for commercial projects requiring coordination with utilities, drainage contractors, or municipal permits. Owners who contact contractors in July hoping for an August installation frequently find themselves rescheduled into fall shoulder season—which, in Wisconsin, means working against shortening paving windows as overnight temperatures approach the 50°F threshold below which quality compaction becomes unreliable. Build contractor selection and deposit into your project timeline well before the season you want the work completed.

How to Read an Asphalt Paving Quote

An asphalt paving proposal is only as useful as the scope it describes. A number without a clear scope is not a quote — it is a guess. Before comparing prices, owners should understand what each proposal actually includes.

A thorough paving proposal should specify: whether existing pavement is being removed or overlaid, what excavation or grading work is included, what base design is being used (thickness and material type), what asphalt thickness and mix type is being installed, how drainage is being handled, what edge and transition work is included, and whether striping, utility adjustments, or other finishing items are part of the scope.

When two proposals differ significantly in price, the first question should be: what does each scope include? Not: which contractor is cheaper? A lower proposal that excludes base correction, drainage work, or proper removal is not a better deal — it is a deferred cost. In paving, work that is skipped during construction almost always costs more to address after the pavement is in place.

  • Practical tip: Ask each contractor to walk you through what happens first, second, and third on your project. A contractor who can explain the sequence of work — grading, base prep, compaction, asphalt lifts, finishing — in plain language is demonstrating the knowledge to execute it correctly.

A legitimate paving proposal should specify, at minimum: the square footage being paved, whether existing pavement is being removed or overlaid, the excavation depth and base specification (material type and compacted thickness), the asphalt mix design and total compacted thickness, how drainage is being addressed, what edge and transition work is included, whether utility adjustments are in scope, what striping or markings are included, the payment schedule (legitimate contractors do not require full payment upfront), and an estimated project timeline. Any proposal that is a single line item — "pave driveway, $X,XXX" — is not a scope. It is a number with no accountability behind it.

Payment terms are a useful signal of contractor legitimacy. Reputable paving contractors typically require a modest deposit of 10 to 30 percent to schedule the job, with the balance due upon satisfactory completion. Contractors who demand full payment before work begins, or who accept only cash, are operating outside standard industry practice. The Wisconsin Better Business Bureau has documented repeated cases of paving contractors — many operating door-to-door with claims of "leftover asphalt" — collecting large upfront payments and delivering substandard work or disappearing entirely, with homeowner losses reaching $8,000 or more per incident.[7]

Why Two Asphalt Quotes Can Be So Different

This is the question many property owners most want answered. Two contractors look at the same driveway or parking lot and come back with numbers that are thousands of dollars apart. Why?

The most common reason is scope difference, not contractor quality. One contractor may include full removal, grading correction, stronger base prep, thicker asphalt, and drainage work. The other may propose an overlay on the existing surface, minimal prep, and a thinner section. Both proposals reference the same address and the same square footage. They describe fundamentally different projects.

There can also be legitimate differences in overhead, equipment, insurance, and how each contractor prices risk. A contractor who has done enough work to know that a particular site has drainage problems may price conservatively to account for additional work they expect to find. A contractor who is pricing the job off a driveway measurement without a site visit may underestimate what the project requires.

The most useful comparison is not price-to-price. It is scope-to-scope. For each proposal, understand what is being removed, what is being corrected, what the base design is, what traffic assumptions are being made, how drainage is being handled, and what the finished surface is actually built to do. That comparison will tell you far more than comparing dollar amounts.

To make the scope difference concrete: on a 2,000 square foot residential driveway, the difference between a proposal that includes full excavation, 6 inches of compacted aggregate base, and 4 inches of asphalt versus one that proposes a 2-inch overlay on the existing surface is approximately $4,000 to $7,000 in total project cost. Both proposals reference the same driveway. If the existing base is sound, the overlay may be the correct recommendation, and the lower price is legitimate. If the base has failed, the overlay will last 2 to 5 years, and the property owner will spend more on the eventual full replacement than if they had done it right initially. The number alone cannot tell you which situation applies to your property.

Why is the Cheapest Asphalt Paving Quote Is Not Always the Best Value

A lower number is not automatically a better deal if it excludes the work needed to keep the pavement from failing early. This is one of the clearest and most consistent lessons in asphalt paving. According to lifespan data, asphalt installed over a failing base or without proper drainage correction fails significantly earlier — in many documented cases, well before the expected 15 to 25 years.

Replacing a failed driveway costs more than doing it right the first time. It also involves repeated disruption, hauling, and disposal costs. A pavement that lasts 25 years with one resurfacing at year 15 costs far less in total ownership than a pavement that requires full replacement at year 8 because the prep work was skipped. The math is straightforward once the numbers are compared honestly.

This does not mean the highest quote is always right, either. It means owners should understand what is included and what is assumed. The better value often comes from the proposal that most honestly matches the scope of work to the actual site conditions — not the one with the most impressive marketing or the lowest opening number.

The math is straightforward when laid out over time. A driveway installed correctly for $8,000 — with proper base prep, adequate thickness, and drainage correction — that lasts 20 to 25 years with one sealcoat cycle costs approximately $340 to $420 per year of service life. A driveway installed for $4,500 with skipped prep that requires full replacement at year 8 costs approximately $562 per year before the second installation begins. Over a 25-year ownership period, the owner who chose the lower bid has paid more in total and endured two rounds of construction disruption. This is not speculation — it is the predictable consequence of installing a structural pavement product without the structural foundation it requires.

What Asphalt Paving Actually Costs in Southeastern Wisconsin

Generic national price guides list averages that rarely reflect what a real paving project costs in southeastern Wisconsin. Material pricing, asphalt plant distance, regional labor rates, and local market conditions all affect where any given project lands within a national range. What a driveway costs in Waukesha is not necessarily what it costs in Racine or Brookfield, and what a commercial lot costs in Milwaukee is not the same as one in a smaller community with fewer competing contractors and longer plant hauls.

For residential driveways across the region — including Milwaukee, Waukesha, New Berlin, Muskego, Brookfield, Racine, Wind Point, and Kenosha — current market data puts standard asphalt driveway installation (including demolition of an existing surface, base evaluation, and 3 to 4 inches of new asphalt) in a range of roughly $4 to $7 per square foot. Sites with soft soils, drainage problems, retaining walls, tight access, or significant grade change will run higher. New construction driveways without existing pavement to remove may be more competitive depending on site conditions. Smaller communities farther from major asphalt plants — including parts of Walworth, Jefferson, and Washington counties — may see pricing at the upper end of that range due to increased hauling cost.

For commercial parking lots in southeastern Wisconsin, per-square-foot pricing on a straightforward paving-only scope typically falls in the $3 to $5 range for larger lots. Milwaukee and Waukesha have the highest concentration of commercial paving contractors and the most asphalt plant access in the region, which can create competitive pricing on larger jobs. Smaller markets — Racine, Kenosha, Brookfield, and outlying areas — may have slightly less competition and longer plant logistics. Complete commercial lot build-outs, including site prep, concrete curbing, drainage structures, and striping, are full construction projects and should be evaluated as such, regardless of location.

These are honest regional ranges based on available market data. They are not guarantees, and no number in this guide substitutes for an on-site evaluation. Subgrade conditions, drainage, access, and project complexity will all move the final number. The only figure that matters for your specific project is the one based on your actual property.

Maintenance Costs: What to Budget After Paving

A new asphalt surface is the beginning of a maintenance relationship, not the end of a spending decision. Budgeting for maintenance is part of understanding the true cost of asphalt paving.

Sealcoating is the most common and cost-effective maintenance step. It protects the surface from UV oxidation, moisture penetration, and fuel or oil staining. Industry guidance recommends sealcoating 6 to 12 months after a new installation (once the asphalt has fully cured) and every 2 to 5 years after that, depending on traffic and exposure. Current market data puts sealcoating cost at $0.14 to $0.25 per square foot for commercial surfaces and $0.88 to $2.10 per square foot for residential driveways, depending on condition and product.

Crack filling should be addressed as soon as cracks appear, before water infiltrates and begins degrading the base. The cost of crack filling is minor compared to the cost of letting water reach the base layer and accelerating failure. Patching and localized repair pricing vary significantly by the depth and extent of the damaged area.

Total maintenance cost over a 20-year asphalt lifespan typically runs $2,000 to $4,000 for a standard residential driveway, including sealcoating cycles, crack filling, and minor repairs — assuming the original installation was sound. A poorly installed pavement may require major repair or replacement well before that 20-year mark, dramatically increasing total ownership cost.

A practical maintenance schedule for a new asphalt driveway in Wisconsin looks like this: wait 6 to 12 months after installation before applying the first sealcoat, allowing the asphalt binder to fully cure and offgas. Apply sealcoat every 3 to 5 years thereafter. Fill cracks immediately when they appear — crack filler costs $0.50 to $2.00 per linear foot applied professionally and is the single most cost-effective maintenance investment available, because every dollar spent on crack sealing before water infiltrates saves an estimated $6 to $10 in future repair costs. At approximately years 12 to 15, evaluate whether resurfacing is appropriate. A well-maintained surface at that age may need only a thin overlay; a neglected one may require full replacement.

What to Ask Before Signing Any Asphalt Paving Contract

Instead of leading with "How much per square foot?" — the question that generates the least useful answer — property owners consistently get better results when they ask questions that reveal the scope behind the number.

The most useful questions before accepting a paving proposal include: What preparation work is included in this proposal, and why? Is the existing pavement being removed or overlaid, and what determines that recommendation? What is the base design — how thick, what material, and how will it be compacted? Are there any drainage issues on this site, and how are they being addressed? What asphalt thickness is being specified, and is it appropriate for the traffic this surface will carry? What is included in finishing details — edges, transitions, utility adjustments, striping? What is the expected lifespan of this installation, and what maintenance would you recommend? And — critically — what would you add or change if budget were not the primary constraint?

That last question is often the most revealing. A contractor who can answer it specifically and honestly — not as a sales pitch but as a technical recommendation — is demonstrating the knowledge and integrity to build a pavement that performs.

Three questions cut through most contractor ambiguity faster than any others. First: what is the compacted base thickness, and what material are you using? A contractor who cannot answer this specifically does not have a structural design — they have a price. Second: What asphalt mix are you specifying and at what compacted depth? Surface mix and binder mix serve different functions; a contractor who does not distinguish between them may not be installing a proper pavement system. Third: How are you handling drainage on this site? The answer reveals whether they walked the property carefully or measured it from the street. These three questions will tell you more about the quality of a proposal than any amount of marketing material or online reviews.

How to Choose an Asphalt Paving Contractor: What to Look For and What to Avoid

Asphalt paving attracts a higher-than-average share of fraudulent operators because the barrier to entry appears low—a truck, a load of mix, and a willingness to knock on doors. The Wisconsin Better Business Bureau, CBS58 Milwaukee, and FOX6 News have all documented paving scams in the state, with individual homeowner losses as high as $8,000. The most common pattern: a crew shows up unsolicited, claims to have ‘leftover asphalt’ from a nearby job, offers a suspiciously low price for same-day work, collects a large cash deposit or full payment upfront, and delivers either substandard work or no work at all. The ‘leftover hot-mix’ claim is a reliable fraud signal: hot-mix asphalt must be placed within 30–90 minutes of leaving the plant at temperatures of 275–325°F. There is no such thing as leftover hot-mix that can be reused the next day or transported door-to-door.[7] [8] [9]

Vetting a legitimate contractor requires three verifiable credentials: an active business license or contractor registration in the state where work is being performed, a current certificate of general liability insurance (minimum $1 million per occurrence is standard in the industry), and a verifiable business address—not just a cell phone number. In Wisconsin, contractors performing work above certain dollar thresholds must be registered with the Department of Safety and Professional Services; a legitimate contractor will provide their registration number without hesitation. Request the insurance certificate directly from the contractor's insurer, not a printed copy delivered to your door. References from completed commercial projects in the past 12 months are also a standard ask; a contractor who cannot provide three verifiable recent references is either new to the market or operating without a stable customer base.

Payment structure is one of the clearest indicators of legitimacy. Established paving contractors typically require a deposit of 10–30% at contract signing to cover mobilization and material costs, with the balance due on satisfactory completion. Any contractor demanding more than 50% upfront—or full payment before work begins—is operating outside industry norms. Cash-only payment requirements with no written contract are a hard stop: walk away. A written scope of work should specify exact square footage, pavement thickness in inches, number of asphalt lifts, base preparation method, drainage provisions, and any warranty terms—typically one to two years for workmanship on residential projects. If a contractor cannot or will not put these specifics in writing before work begins, that is the contract you will have to live with after the equipment leaves your property.

What a Thorough Asphalt Paving Estimate Actually Looks Like

A qualified paving contractor arrives at a property, thinking about the site — not the sale. The first job is to understand what the pavement system is actually doing, where it is succeeding, and where it is failing. That evaluation starts before a tape measure comes out.

A proper site walk covers the full surface condition: where water drains and where it does not, how edges and transitions are holding up, whether low spots or utility structures have shifted, and what the existing surface is telling you about what happened in the base below it. Cracks, settlement patterns, and drainage failures are diagnostic information — not just cosmetic problems.

Before any measurement is taken, the scope conversation matters. What is the surface being used for? What traffic will it carry? What is the owner's goal — a long-term replacement or a cost-managed overlay? The answers shape the structural design. An honest estimate follows the site conditions and the owner's actual goals, not a price point designed to win a bid. If the existing base is sound and an overlay is the right call, that is what should be recommended. If full replacement is the only durable path, the evidence for that recommendation should be explained clearly — not assumed.

Once the scope is established, a thorough estimate accounts for every real cost: material tonnage based on actual thickness specifications, base requirements, labor, equipment, fuel, mobilization, and appropriate overhead. The number on a quality proposal reflects the project as it actually exists — not a square-footage guess optimized to be the lowest number in the inbox.

For property owners in southeastern Wisconsin — including Muskego, New Berlin, Brookfield, Waukesha, Milwaukee, Racine, Wind Point, Kenosha, Ozaukee, Washington, Jefferson, and Walworth counties — the same principles apply regardless of which contractor performs the work. A free on-site evaluation based on actual site conditions is the only starting point that produces a reliable cost estimate.

  • If you want to understand what your project will actually cost, the most useful first step is a free on-site evaluation. No generic numbers. No pressure. Just an honest look at your property and a clear proposal built on what it actually needs

Cited Resources

[1] National Asphalt Pavement Association (NAPA). "Asphalt Pavement Industry Survey on Recycled Materials and Warm-Mix Asphalt." asphaltpavement.org. https://www.asphaltpavement.org/

[2] Federal Highway Administration (FHWA). "Recycled Asphalt Pavement (RAP): State of the Practice." U.S. Department of Transportation. https://www.fhwa.dot.gov/pavement/recycling/rap/

[3] Asphalt Institute. "Thickness Design — Asphalt Pavements for Highways and Streets" (Manual Series No. 1, MS-1). Lexington, KY: Asphalt Institute. https://www.asphaltinstitute.org/

[4] American Association of State Highway and Transportation Officials (AASHTO). "Guide for Design of Pavement Structures." Washington, D.C.: AASHTO. https://www.transportation.org/

[5] Transportation Research Board. "Relationship Between Crude Oil Prices and Asphalt Binder Costs." Transportation Research Record: Journal of the Transportation Research Board. https://journals.sagepub.com/home/trr

[6] S&P Global Commodity Insights / OPIS. "Bitumen North America Spot Price Data." Market pricing as of December 2025. https://www.opisnet.com/

[7] Better Business Bureau of Wisconsin. "Paving Contractor Scam Alerts and Consumer Warnings." BBB Serving Wisconsin. https://www.bbb.org/us/wi/

[8] CBS58 Milwaukee. "Paving scam warnings: Wisconsin homeowners targeted by door-to-door crews." WDJT-TV Milwaukee. https://www.cbs58.com/

[9] FOX6 News Milwaukee. "Driveway paving scammers target Wisconsin homeowners; BBB issues alert." WITI-TV Milwaukee. https://www.fox6now.com/

[10] American Concrete Pavement Association (ACPA). "Concrete Pavement Life-Cycle Performance and Cost Comparison Studies." acpa.org. https://www.acpa.org/

[11] FHWA. "Pavement Preservation: Getting More Miles Out of Rural Roads — Life-Cycle Cost Analysis." Federal Highway Administration, U.S. DOT. https://www.fhwa.dot.gov/pavement/preservation/

[12] Pavement Preservation and Recycling Alliance (PPRA). "Benefits and Cost-Effectiveness of Preventive Pavement Maintenance." pprainfo.org. https://roadresource.org/
